Latner Documentation

How to Update the Next Service Due Date or Hours for Equipment

Service schedules tell Latner when each machine is next due for a service, and the Equipment Due for Service screen lets you move that next due date or hour reading when reality does not match the schedule.

Overview

Schedules are tidy; job sites are not. A machine sits idle for a month, a mechanic gets to it a fortnight early, or a customer asks you to service on site while you are already there. Latner sets the next due point automatically, but you can override it for a single machine without disturbing anyone else on the same schedule.

  • Every service schedule on a machine has its own next due point: a Service Due Date, a Service Due Meter/Hours reading, or both.

  • Latner sets that due point when the schedule is first assigned, and sets the following one each time a service work order is completed.

  • You override it from Service › Equipment Due For Service, one row at a time.

  • The due point you edit belongs to that one machine, even when the schedule itself was set up on an equipment class or model.

  • An override moves one occurrence only. The service after it is still worked out from the completion date and completion meter reading plus the schedule's own recurrence.

Before You Begin

You need access to the screen, and the machine needs a service schedule already on it.

Requirement

Where to Find It

Equipment Due For Service screen permission

Security › Configuration › Permission Groups, under Service › Screen

A serialized machine with at least one service schedule

The equipment record's Service Schedules tab; add one with Options › Add Service Schedule

The schedule row is still Pending

The Status column on the equipment record's Service Schedules tab

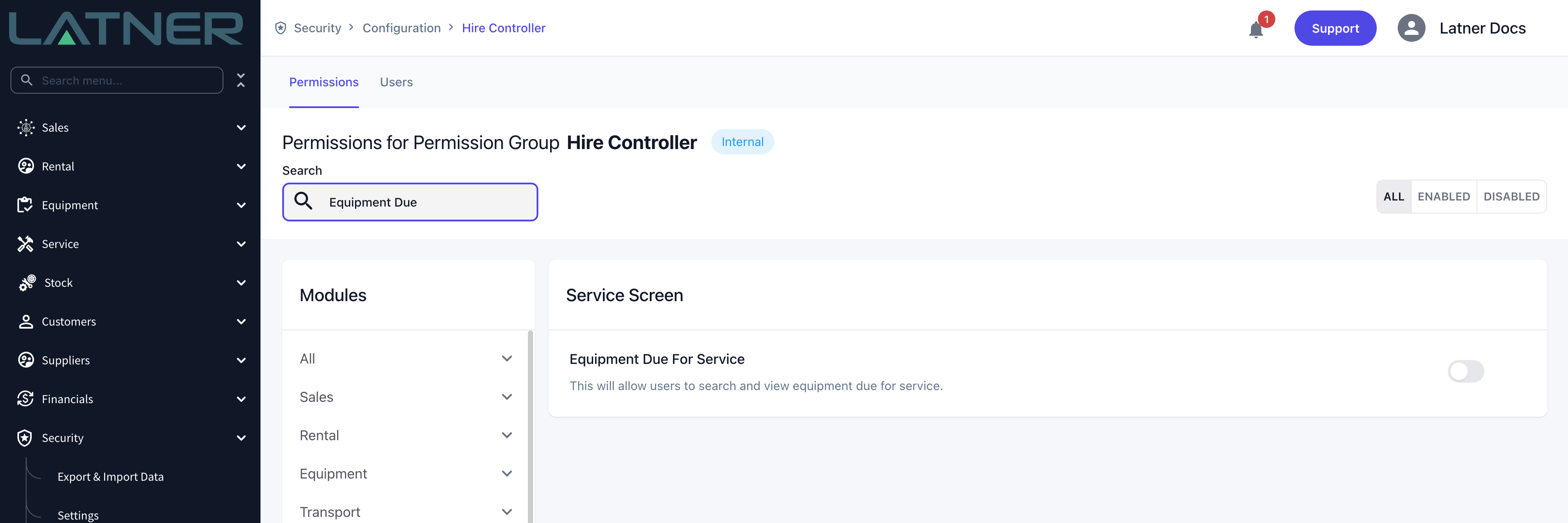

The Equipment Due For Service screen permission on a permission group. Without it the screen is hidden from the Service menu entirely

Equipment Due for Service lists only schedules in Pending status on equipment that is still in your fleet. A schedule that has already been turned into a work order (Open), one that has been completed, and one that has been disabled are all left out, as is equipment that is Inactive, Sold, Disposed, Converted or Pending Activation. If a machine is missing, check its Service Schedules tab first.

Updating the Next Service Due Date or Hours

Step 1 - Open the Equipment Due for Service screen

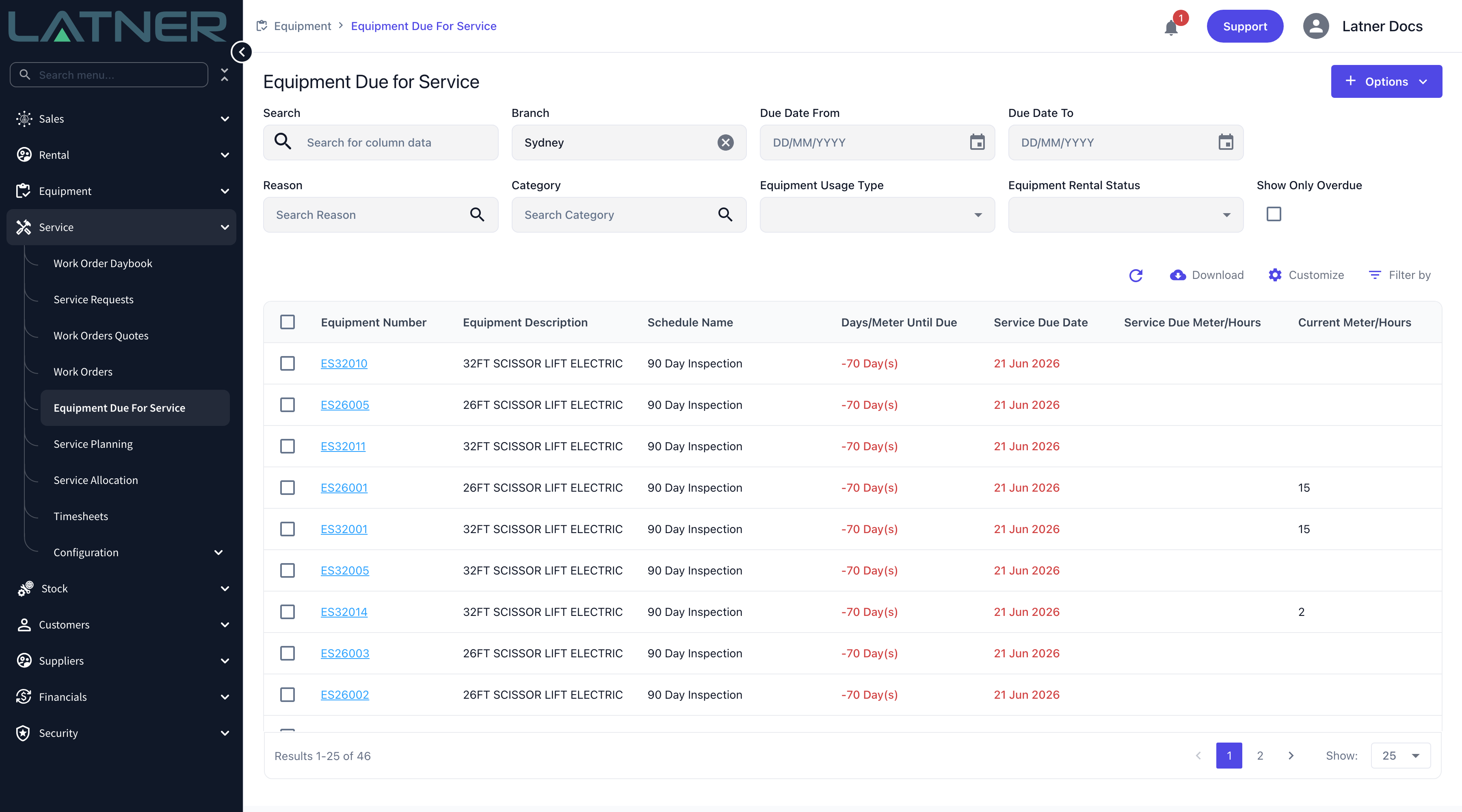

Go to Service › Equipment Due For Service. Every pending service schedule in your branch is listed, one row per schedule per machine, sorted with the most urgent first. Overdue rows are red, rows falling due within the next seven days are amber, and a meter-driven row turns amber once the current reading is inside the last fifth of its interval and red once it has passed the due reading.

The screen opens filtered to your own branch. Clear the Branch filter to see machines held elsewhere

Step 2 - Find the schedule you want to move

Search on equipment number, description, schedule name or the customer the machine is on rent to, or narrow the list with the filters above the grid.

  • Branch - defaults to your own branch, and takes more than one.

  • Due Date From and Due Date To - only affect date-driven schedules.

  • Reason and Category - the work order reason and category the schedule will use.

  • Equipment Usage Type and Equipment Rental Status.

  • Show Only Overdue - uses the forecast in Days/Meter Until Due, so it catches machines that are past their due hours as well as past their due date.

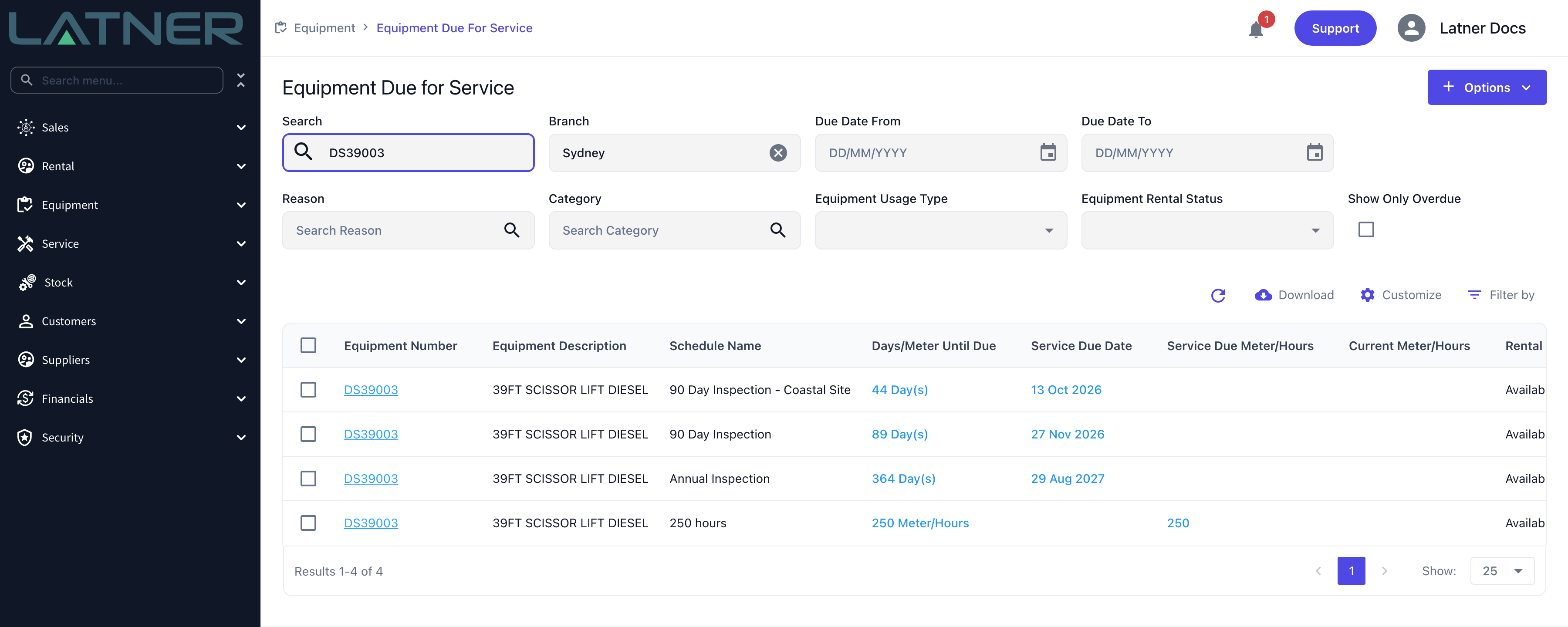

A machine with several schedules appears once per schedule, so check the Schedule Name column before you select a row.

Searching one machine shows each of its pending schedules as a separate row, and the 250 hours schedule is measured in hours rather than days

Step 3 - Select the row

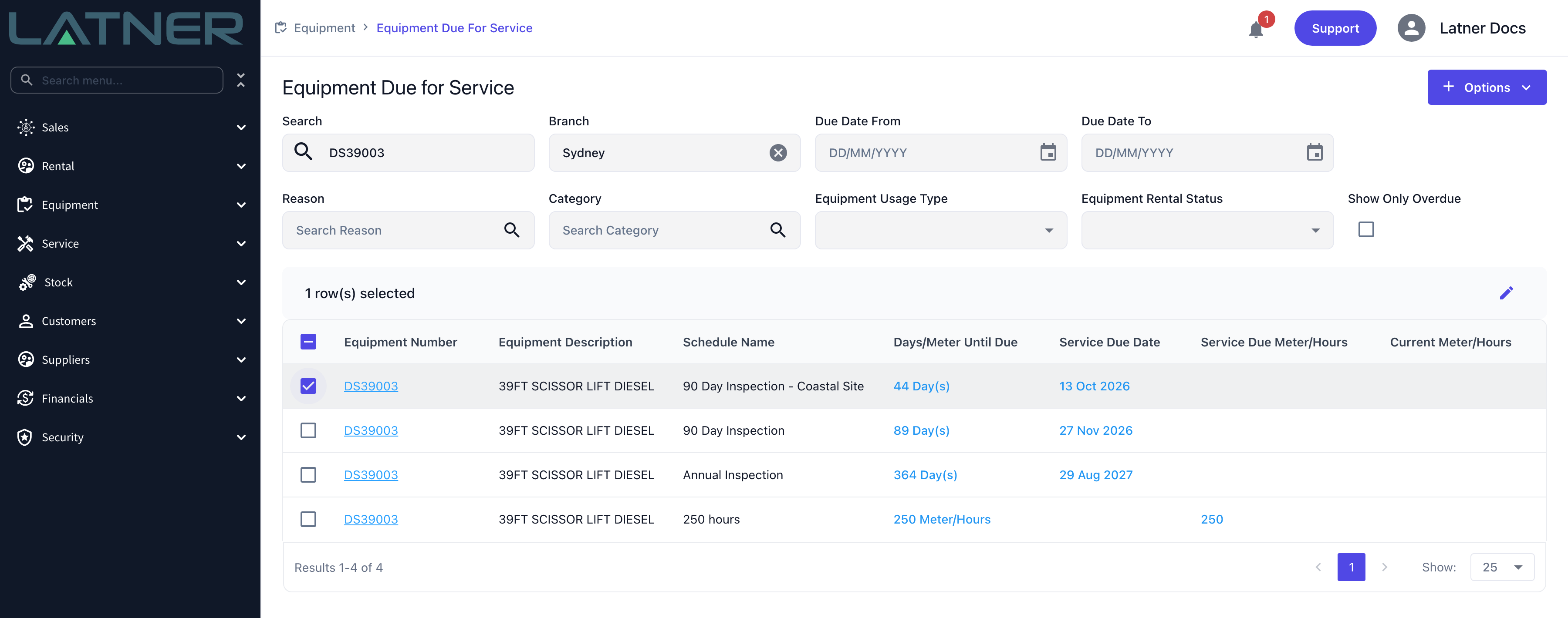

Tick the checkbox at the left of the row. A 1 row(s) selected bar appears above the grid with an Edit pencil at its right-hand end. Click the pencil.

You can only edit one row at a time. Tick a second row and the pencil greys out with the tooltip Only 1 line can be selected.

Ticking a single row reveals the Edit pencil at the right of the selection bar

Step 4 - Enter the new due point

The Update Service Schedule dialog shows only the fields the schedule actually uses, so what you see depends on how the schedule was set up.

  • Due Date - shown when the schedule recurs on days. It is required, so you can change it but not clear it.

  • Due Hours / Meter - shown when the schedule recurs on hours or kilometres. It must be a number, and it is the reading the machine will be at when the service falls due, not the hours remaining.

A schedule set up with both a day interval and an hours interval shows both fields, and whichever comes first drives the service.

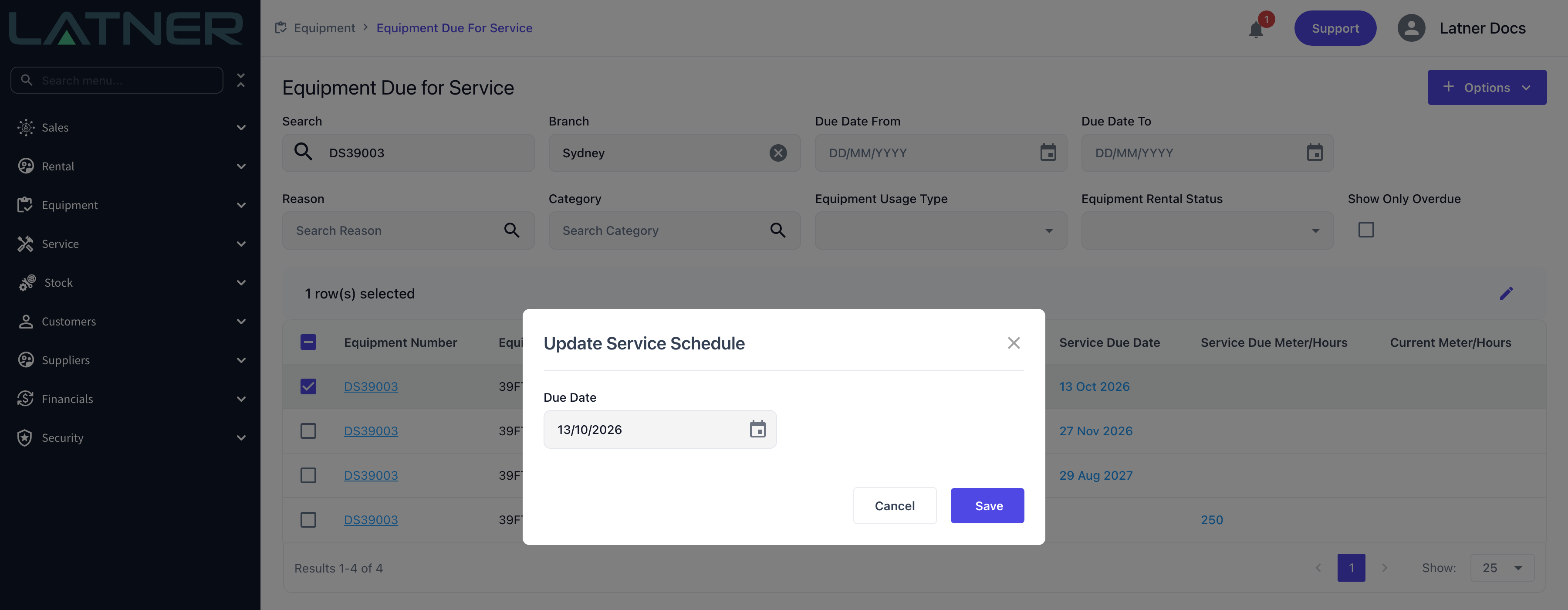

A schedule that recurs on days offers only Due Date

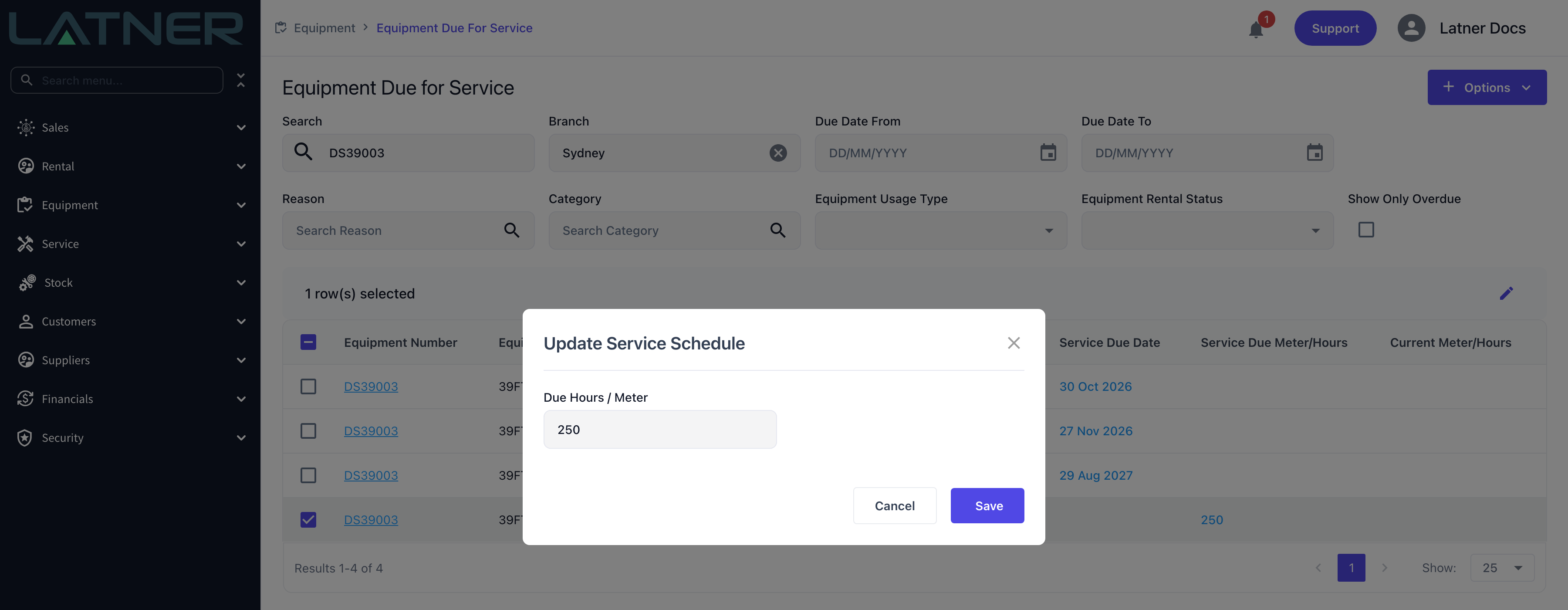

The same dialog on an hours-based schedule offers only Due Hours / Meter, seeded with the current due reading

Step 5 - Save

Click Save. Latner confirms with Service Schedule Detail Updated, the grid refreshes and Days/Meter Until Due is recalculated against the new due point, which may move the row up or down the list.

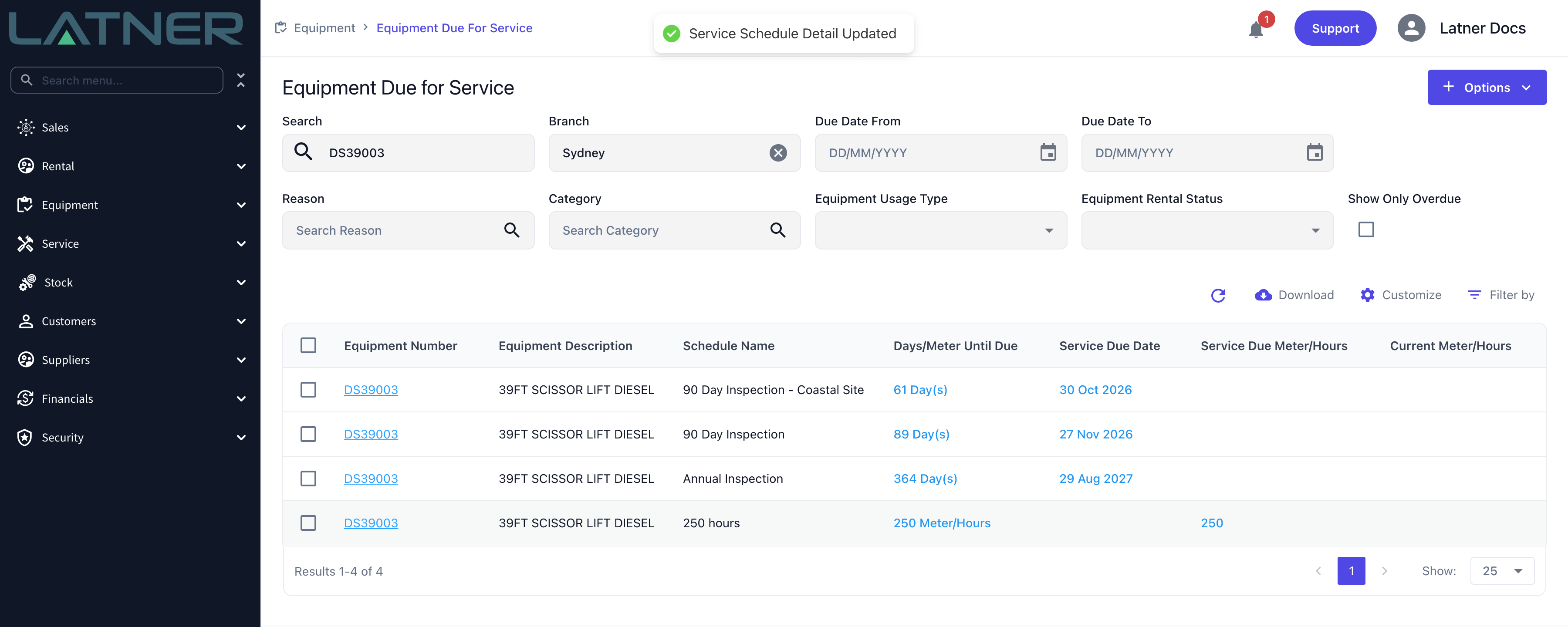

The forecast recalculates as soon as the change is saved - 44 days became 61 when the due date moved from 13 October to 30 October

After Updating

  • The equipment record's General Details card picks up the change straight away: Next Service Date, Next Service Reading and Next Service Due all follow the machine's most urgent pending schedule.

  • The equipment record's Service Schedules tab shows the new Service Due Date and Service Due Meter/Hours against that schedule.

  • The row stays Pending. Editing the due point does not create, change or cancel a work order - use Options › Create Work Order on the same screen when you are ready to book the service in.

  • For an hours-driven schedule Latner converts the hours still to run into days using the machine's average daily meter usage, which is why the row can change position in the list even though you only touched a meter reading.

  • If Equipment Warning Threshold for Days Until Next Service or Equipment Warning Threshold for Meter Reading Hours Until Next Service is set under Security › Settings › Equipment, the warning raised when the machine is added to a rental contract now uses the new due point.

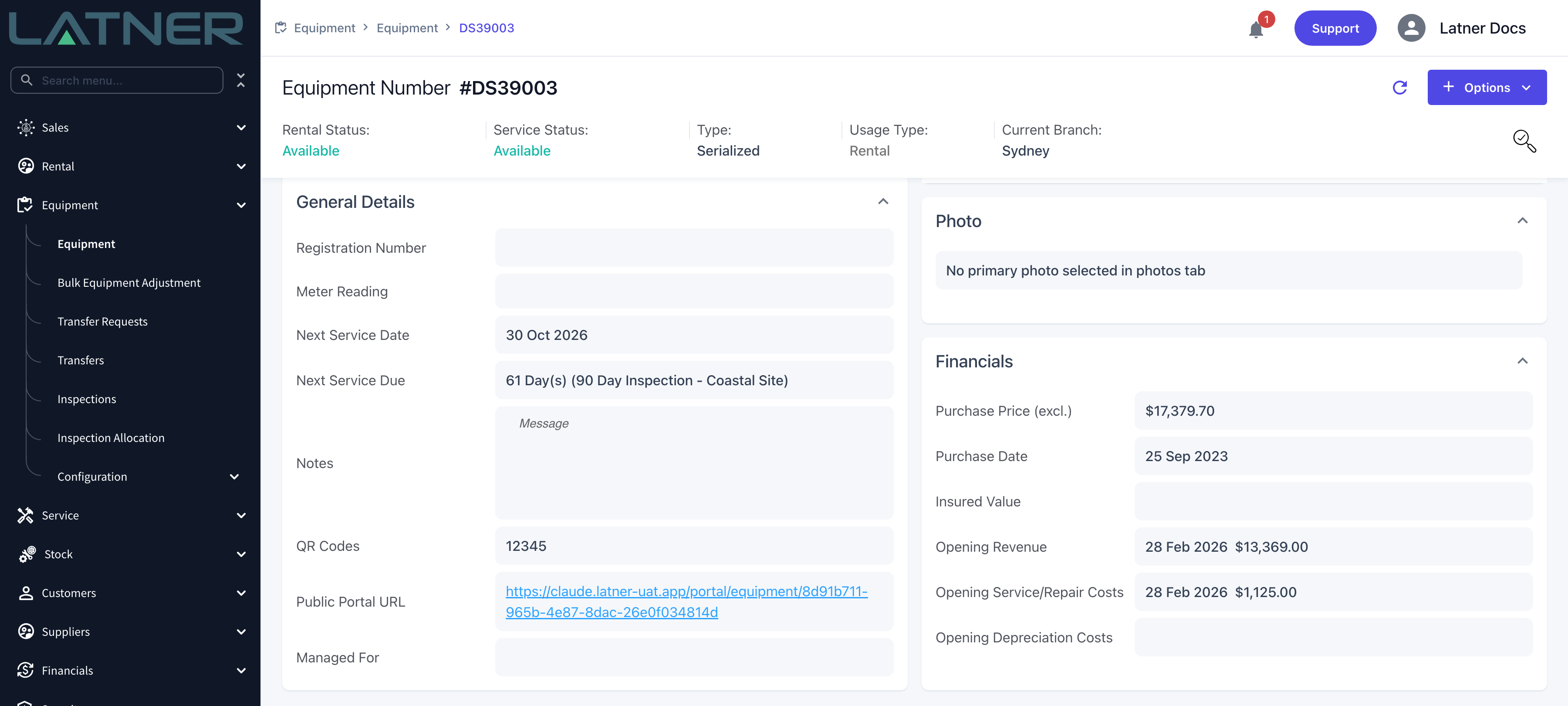

Next Service Date and Next Service Due on the equipment record follow the machine's most urgent pending schedule

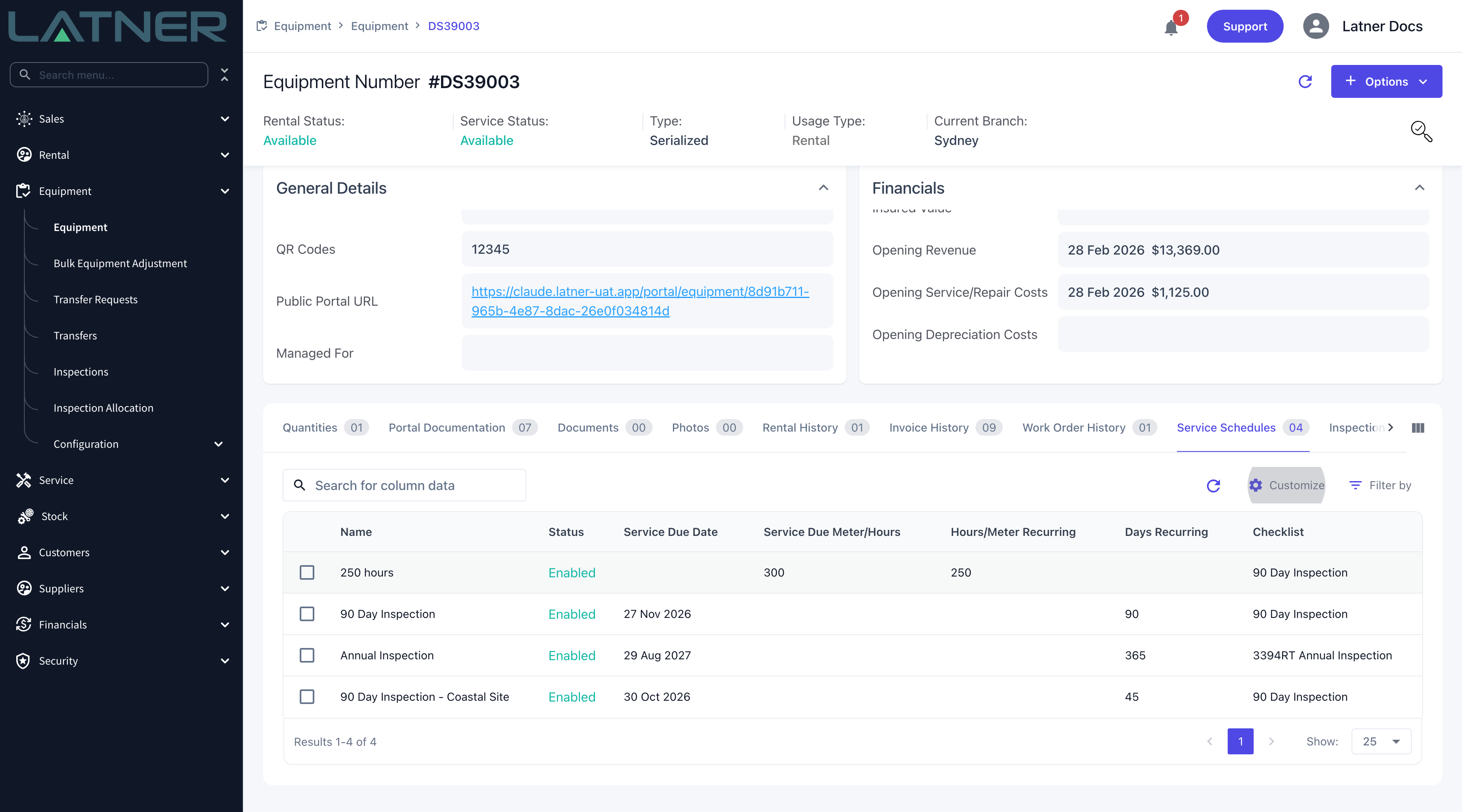

The Service Schedules tab lists every schedule on the machine with its own due date, due hours and recurrence

An override moves one occurrence only. When the resulting work order is completed, Latner works the following due point out from the completion date and completion meter reading plus the schedule's recurrence - not from the value you typed here. If a machine genuinely needs a different interval from the rest of its class, give it its own schedule with Options › Add Service Schedule on the equipment record instead of overriding the date every cycle.

FAQs

The Edit pencil is greyed out. Why?

You have more than one row ticked. The pencil edits a single service schedule row, so untick everything except the one you want and the tooltip Only 1 line can be selected will clear.

The dialog only shows Due Date, but I need to change the hours.

The dialog offers only the fields the schedule drives. A schedule built on a day interval has no due hours to change, so nothing is hidden from you - there is simply no hours target on that schedule. To service the machine on hours, add a schedule with an Hours / Meter Recurring value.

The machine isn't in the list at all.

Three things usually explain it. The Branch filter defaults to your own branch, so clear it if the machine is held elsewhere. The screen lists only Pending rows, so a schedule already turned into a work order, completed or disabled will not appear. And equipment that is Inactive, Sold, Disposed, Converted or Pending Activation is excluded regardless. The equipment record's Service Schedules tab shows every schedule and its status.

Can I change the due date from the equipment record's Service Schedules tab instead?

No. The pencil on that tab opens the service schedule itself - its name, group, checklist and default work order reason and category - not the next due point. Schedules inherited from an equipment class or model cannot be opened there at all, and tell you so: This Service Schedule must be edited from the Equipment Class/Model screen. The next due date and hours are only editable from Equipment Due for Service.

Can I change the interval rather than the next due point?

Not on an existing schedule. Schedule Start Date, Hours / Meter Recurring and Days Recurring are locked once a schedule has been created, because every future due point is calculated from them. To change the interval, delete the schedule and add it again with the new figures, or add a second schedule alongside it.

The schedule came from an equipment class. Will this change every machine on it?

No. The class or model schedule sets the interval; the due date and due hours you edit live on the individual machine's row. Moving one machine's next service leaves every other machine on the same schedule untouched.

Can I update several machines in one go?

No. Due points are edited one row at a time. You can, however, tick several rows and use Options › Create Work Order to raise service work orders for all of them together.

What do the red and amber figures mean?

For a date-driven schedule, red means the due date has passed and amber means it falls within the next seven days. For an hours-driven schedule, red means the machine's current reading has already passed the due reading and amber means it is inside the last fifth of the interval. Anything further out is shown in blue.

Does moving the due date affect an existing work order or invoice?

No. Only rows that have no work order yet appear on this screen, so there is nothing open to affect. As soon as a service work order is created the row moves to Open and leaves the list; cancel that work order and the row returns to Pending, still carrying the due point you set.
