Latner Documentation

How to Create a Rental Contract

A rental contract is the record that holds a hire together - who it is for, which site it goes to, when it starts and ends, and what goes out on it - so creating one is the first step of every hire you put through Latner.

Overview

Most of a rental contract writes itself. Once you have picked the customer and the site, Latner brings across the site contact, the delivery address, the charge days and the pricing defaults, and leaves you to confirm the dates.

  • Contracts are created from Rental › Rental Contracts using Options › Create Rental Contract. The same option is on the Rental Daybook, and the Customer Rental Rates screen can start a contract with rate lines already on it.

  • A new contract is created in Reserved status. It moves to Active once equipment on it goes on rent.

  • Choosing a customer site fills in the Site Contact, Phone, Email and Address for you. You can override any of them on the contract without changing the site.

  • Charge days per week, damage waiver and environmental levy default from the customer site first, then the customer, then your global rental settings.

  • Saving takes you straight to the new contract and opens Add Details, ready for you to add equipment.

Before You Begin

You need the right permissions and a few pieces of data in place before the option will appear and the contract will save.

Requirement

Where to Find It

Rental Contracts permission - lets you open the screen

Security › Configuration › Permission Groups › your group › Screen

Create Rental Contract permission - shows the option in the Options menu

Security › Configuration › Permission Groups › your group › Option

Default Charge Days Per Week - a fallback used when neither the site nor the customer has one

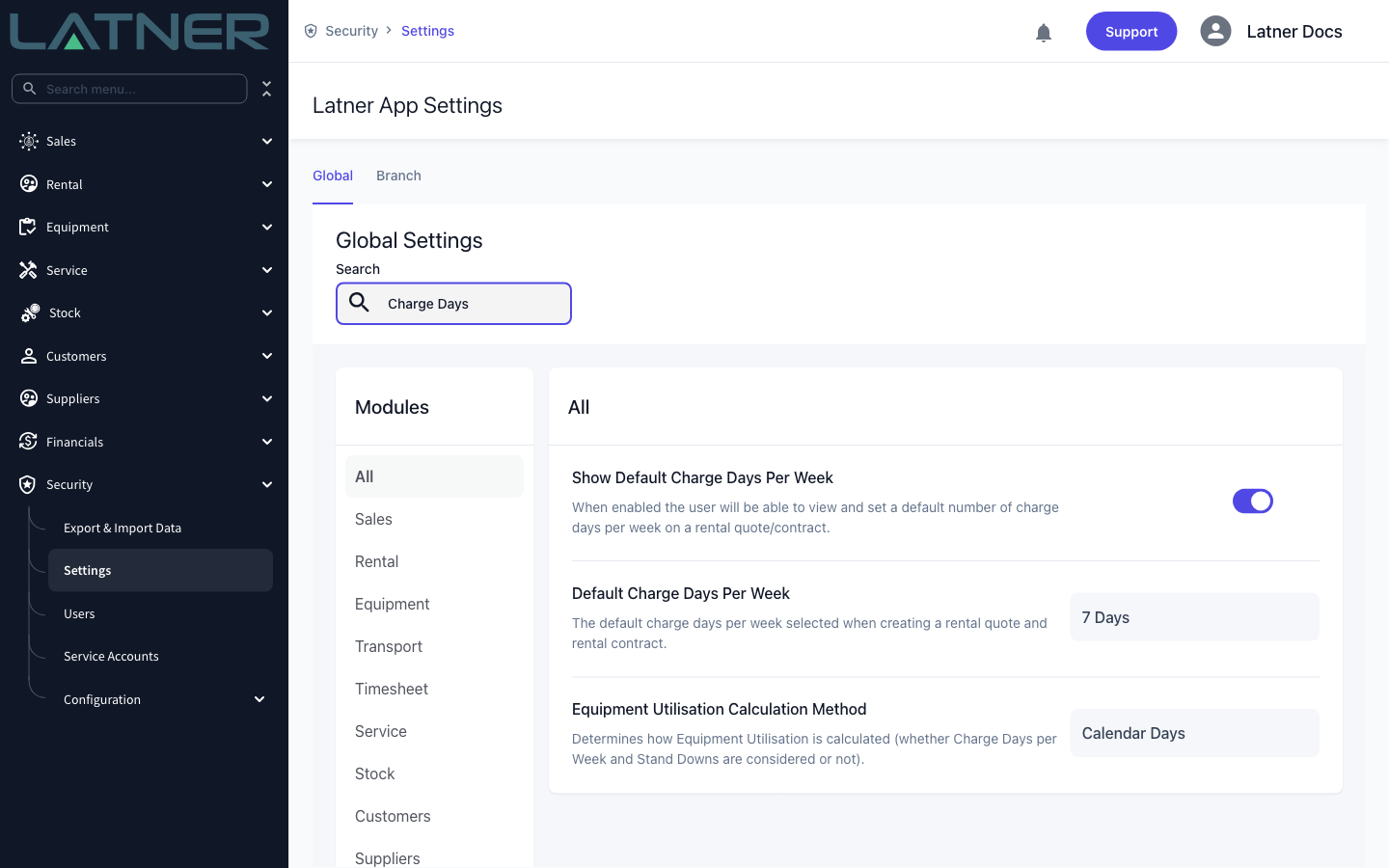

Security › Settings › Rental

Show Default Charge Days Per Week - controls whether the field appears on the form

Security › Settings › Rental

An active customer account that isn't on credit hold

Customers › Customers

A customer site to deliver to

Customers › Customers › the customer › Sites, or create one from the form

Create Rental Contract sits under the Option sub-module, separate from the Rental Contracts screen permission
The rental charge day settings - the default here is only used when the site and the customer don't have one of their own

If Show Default Charge Days Per Week is turned off, the Charge Days Per week field is hidden on the form and Latner works the value out for itself - site, then customer, then the global setting. If none of the three has a value, the contract won't save and you'll be told that a global default hasn't been set.

Creating the Rental Contract

Step 1 - Open the Rental Contracts screen

Go to Rental › Rental Contracts. This is the list of every contract in the system, with its status, customer, site and delivery address.

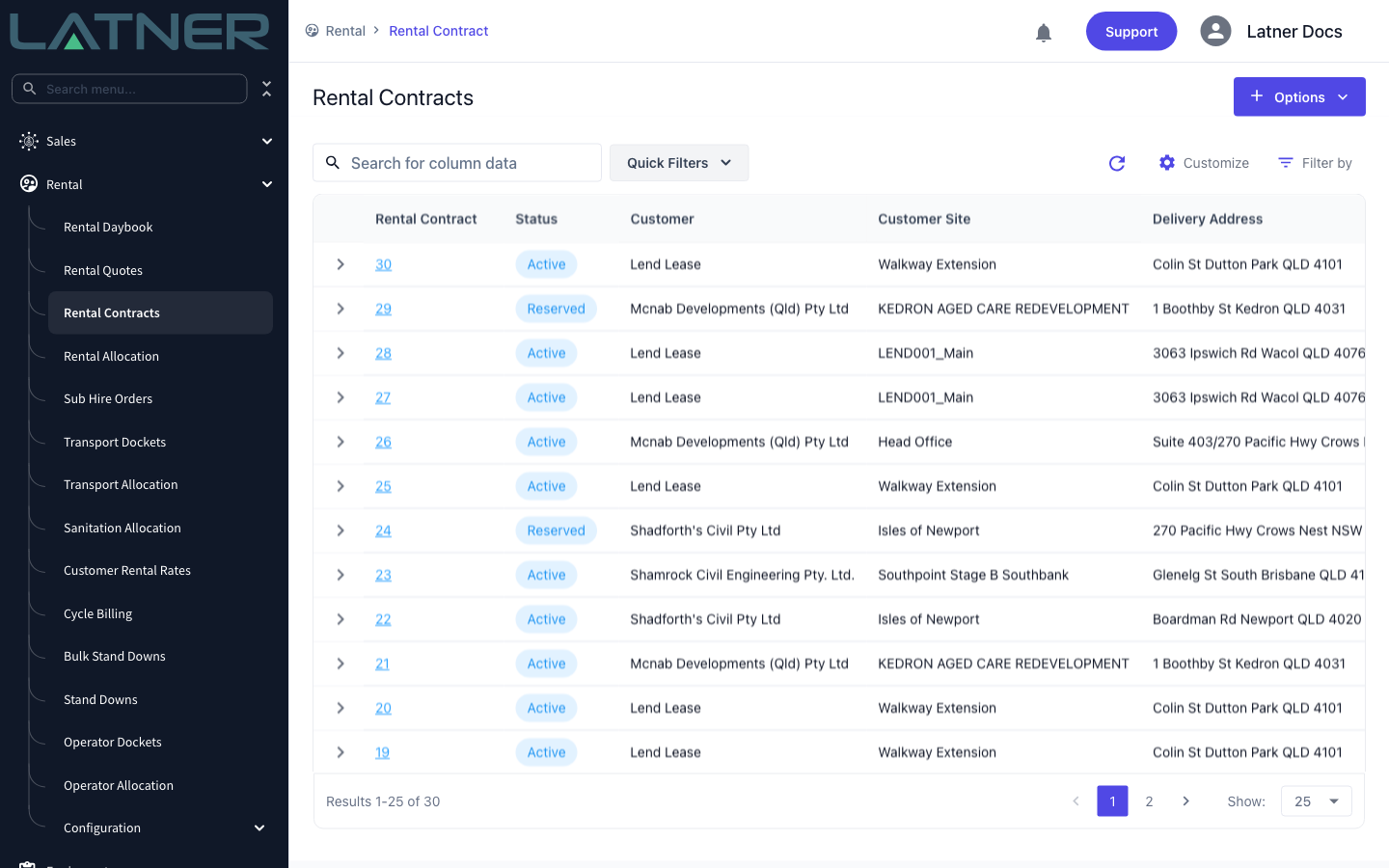

The Rental Contracts screen - Reserved contracts have nothing on rent yet, Active contracts do

Step 2 - Start a new contract

Click Options at the top right, then Create Rental Contract.

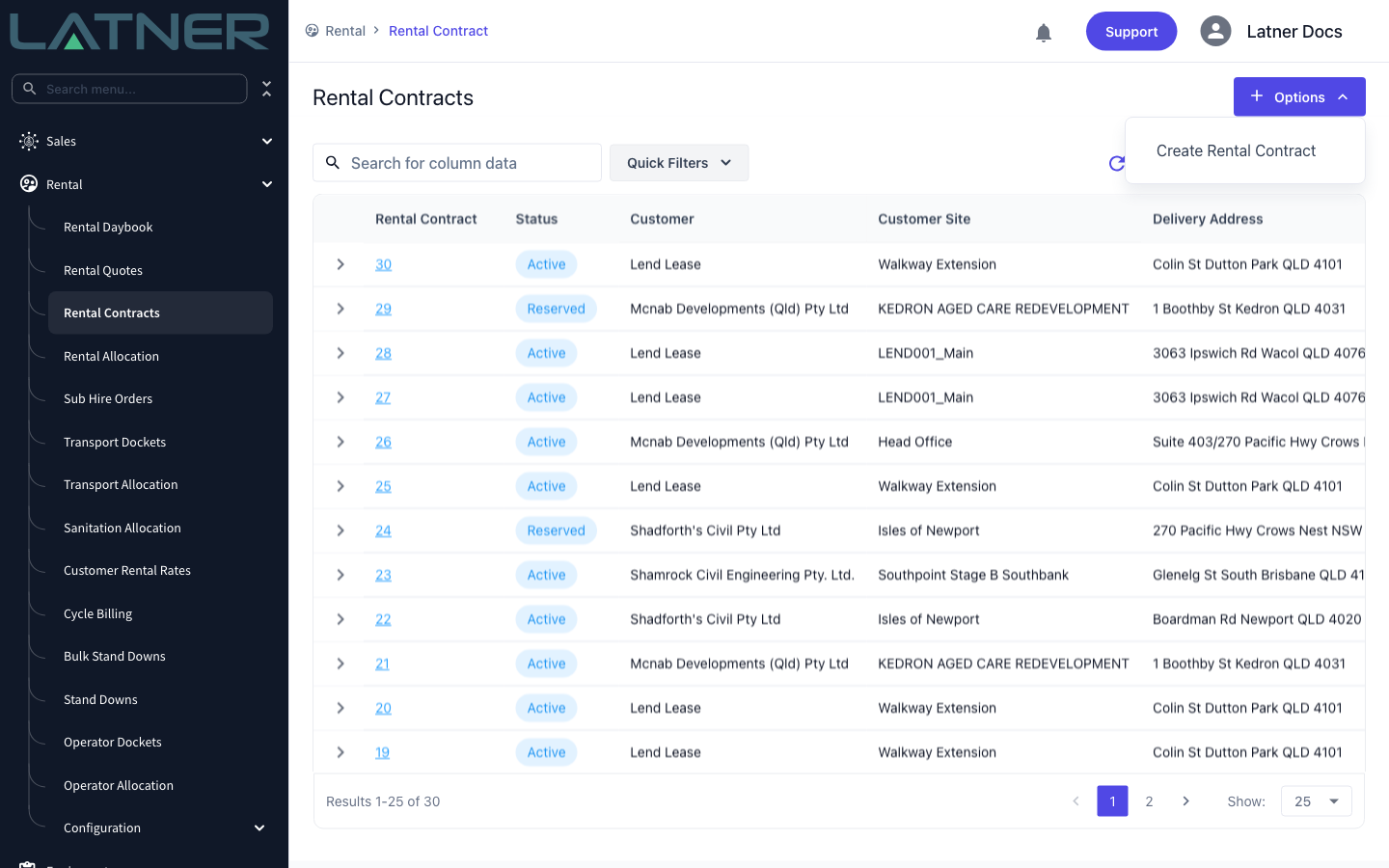

The Options menu on the Rental Contracts screen - the same option is available from the Rental Daybook

Step 3 - Choose the customer

Type into Customer and pick the account from the list. Only active customer accounts appear here, and accounts on cash on delivery terms are shown in red so you can see them at a glance. If the customer isn't in Latner yet, click Create New at the bottom of the list to add them without leaving the form.

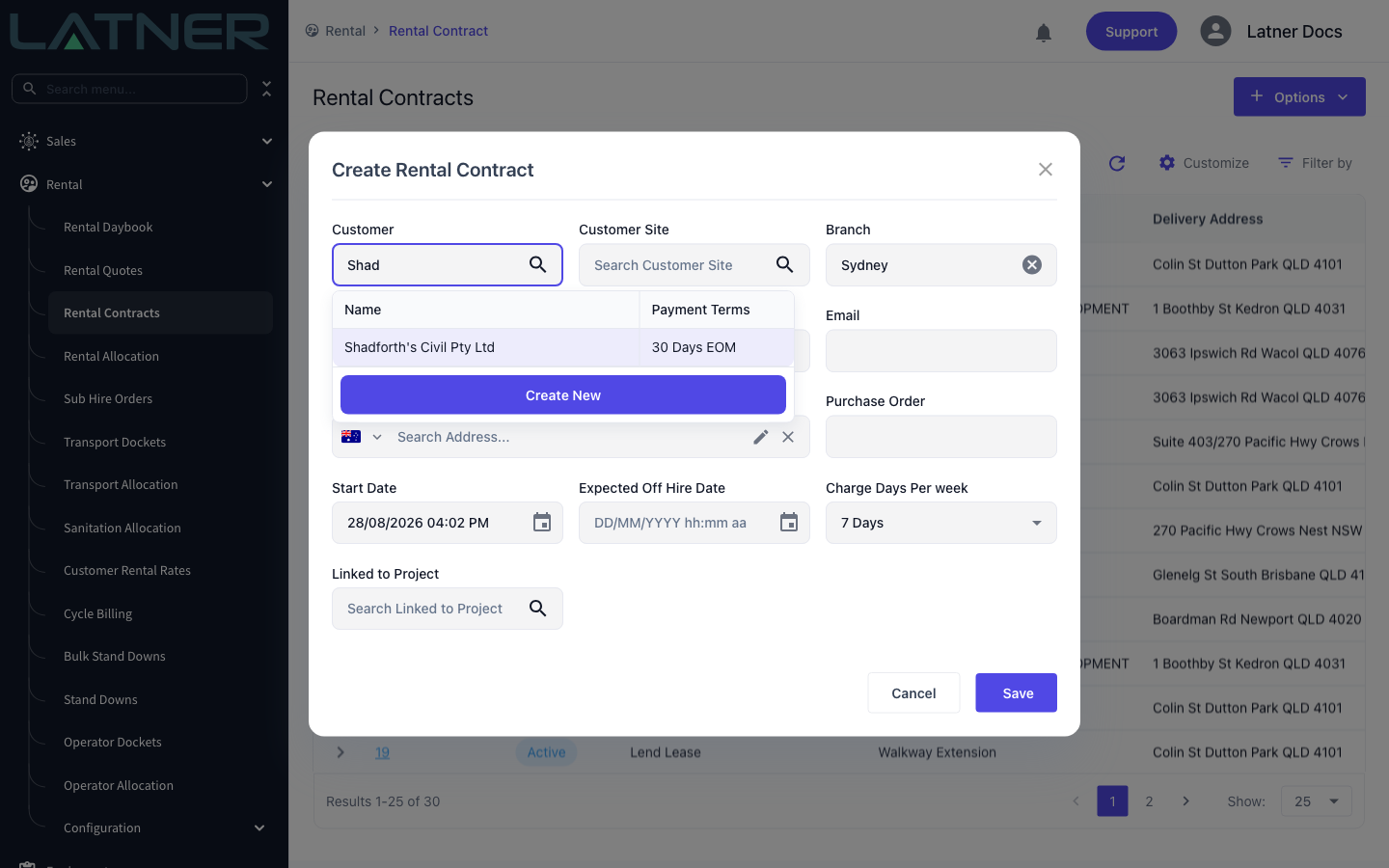

Searching for a customer - the Payment Terms column tells you how the hire will be billed before you commit to it

If the customer has a pop-up note against them, or is on credit hold, Latner shows it as soon as you select them.

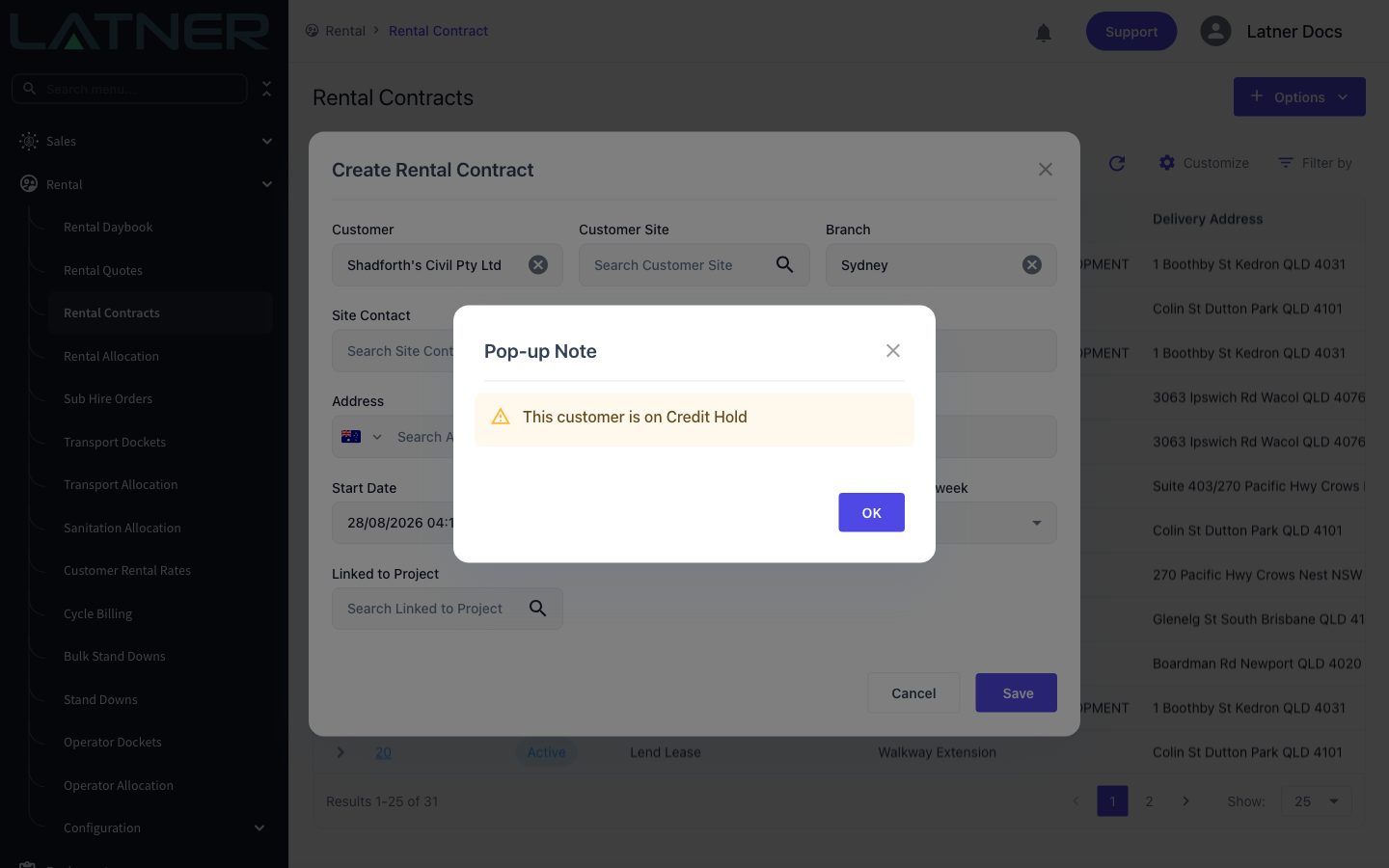

A credit hold warning on customer selection - the form still lets you continue, but the contract won't save until the hold is lifted

Step 4 - Choose the customer site

Click Customer Site and pick where the equipment is going. The list is filtered to the sites belonging to the customer you chose. As with the customer, Create New lets you add a site on the spot.

The customer's sites, with their addresses - picking a site here sets the delivery address for the whole contract

Branch defaults to your own branch and controls which branch the hire belongs to, along with the time zone the dates are read in.

Step 5 - Check the site contact and delivery address

Selecting the site fills in the rest of the delivery block from the site's own details. Check them and change anything that is different for this hire - editing them here does not change the site record.

  • Site Contact - required. The person on the ground. Latner also records them as the contract's Ordered By contact.

  • Phone - required, and pre-filled from the contact.

  • Email - pre-filled from the contact. Whether it is required depends on the Mandatory Customer Site Contact Fields setting.

  • Address - required, and pre-filled from the site.

The contact and address block filled in from the site - anything you change here applies to this contract only

Step 6 - Set the start and expected off hire dates

Start Date defaults to now, or to tomorrow if Default Rental Quote/Contract Start Date to Tomorrow is enabled. With Use Branch Opening & Closing Times enabled, the start and expected off hire times default to the branch's opening and closing times instead.

Expected Off Hire Date is required. Open the picker and you'll find a shortcut box in the bottom left: type a duration and press Enter to set the date relative to the start date. Use d for days, w for weeks, m for months and we to land on the end of a week - so 2w is a fortnight's hire and 10d is ten days.

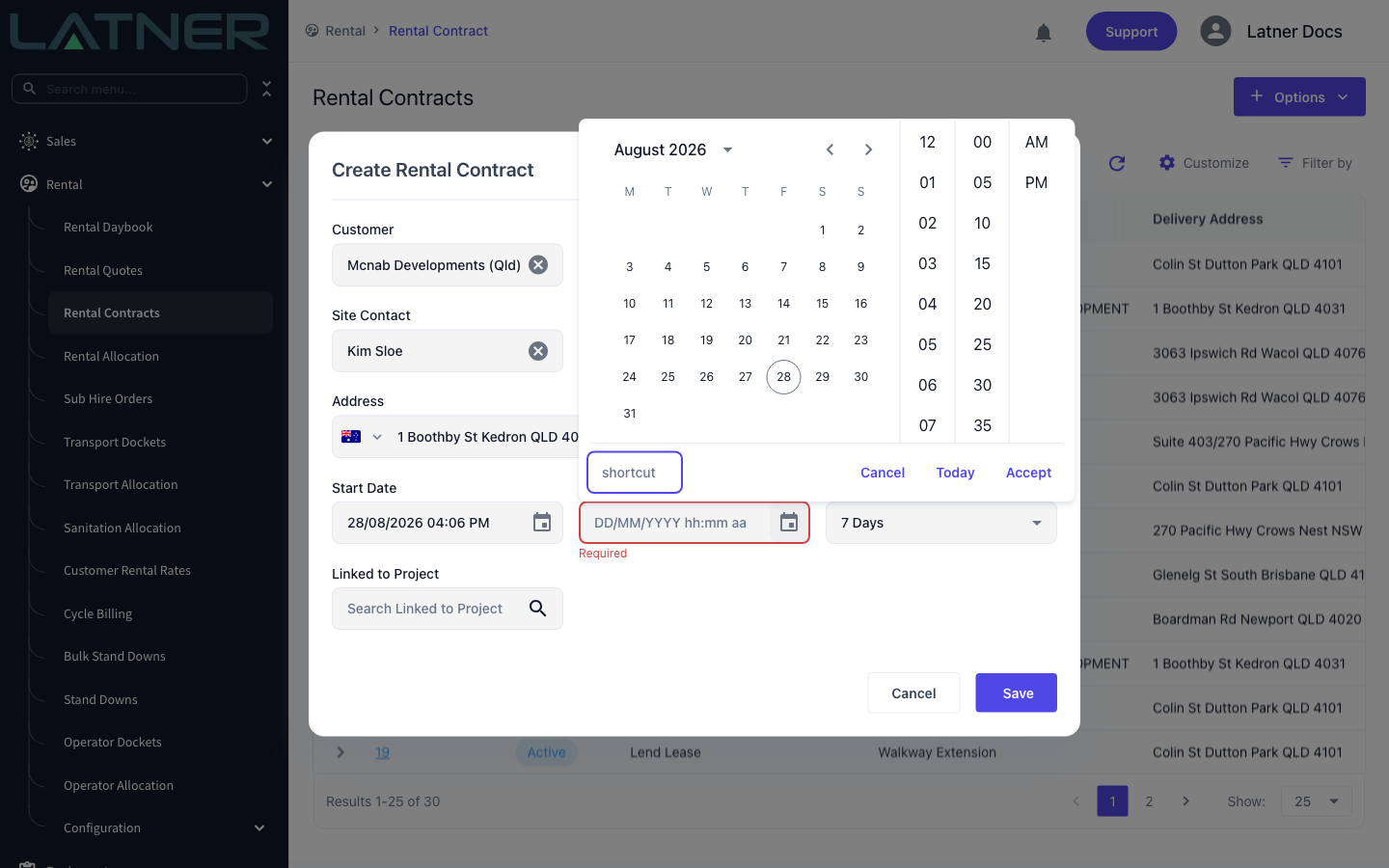

The date picker's shortcut box - quicker than clicking through the calendar for a standard hire period

If the start date falls on a day the customer isn't charged for - a Saturday on 5 day billing, say - a warning appears under the dates. It's a warning only, so you can still save; it's there so you don't accidentally start a hire on a day that bills nothing.

Step 7 - Add the purchase order and check the charge days

  • Purchase Order - optional, and can be added later. Many customers won't approve an invoice without one.

  • Charge Days Per week - required when the field is shown. Choose from 5 Days, 6 Days, 7 Days, Saturday or Weekend. It arrives pre-set from the site or the customer, so only change it if this hire is billed differently.

  • Linked to Project - optional, and only visible when Show Link to Project Field When Creating Rental Contracts is enabled. Links the hire to an in-progress project.

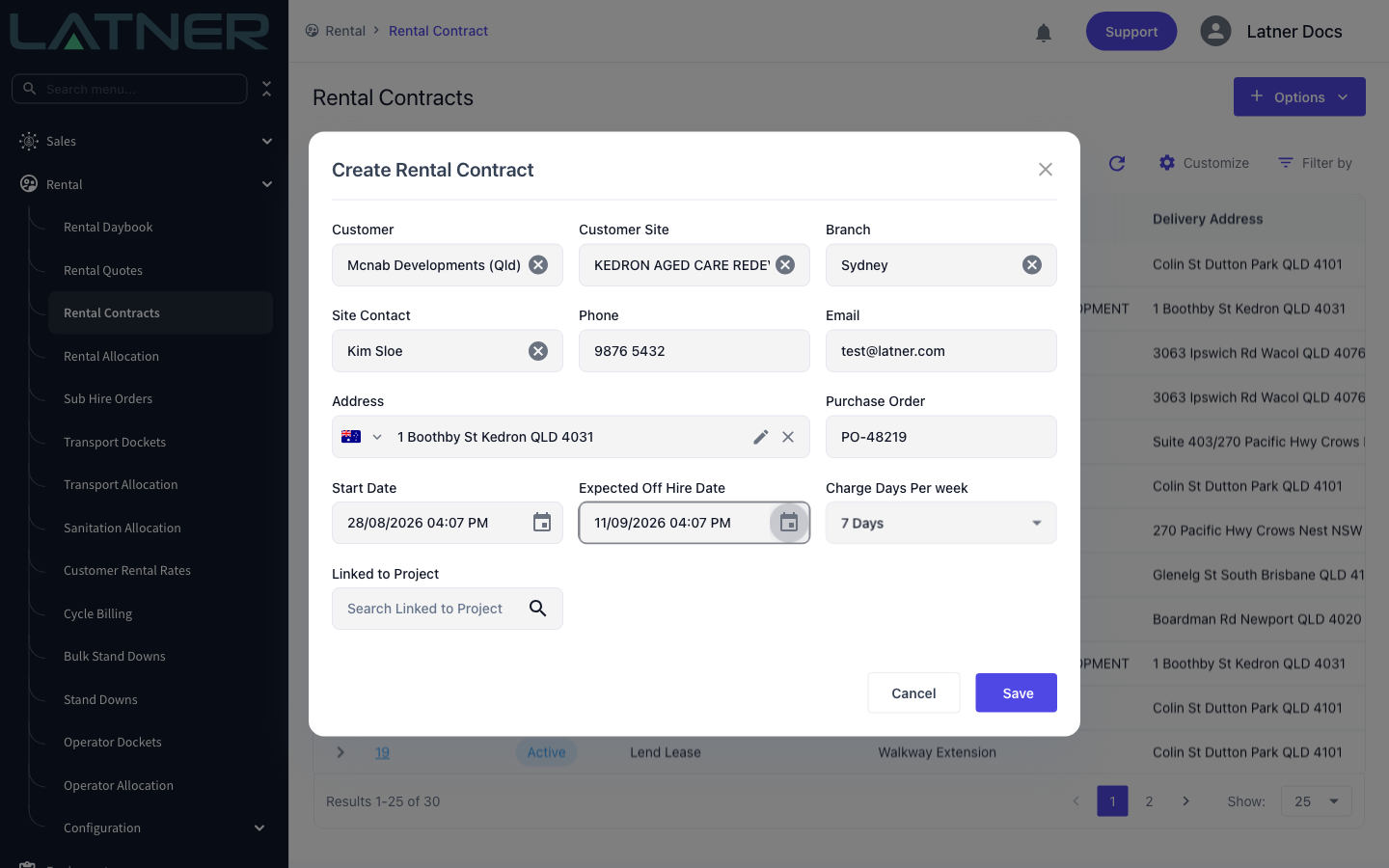

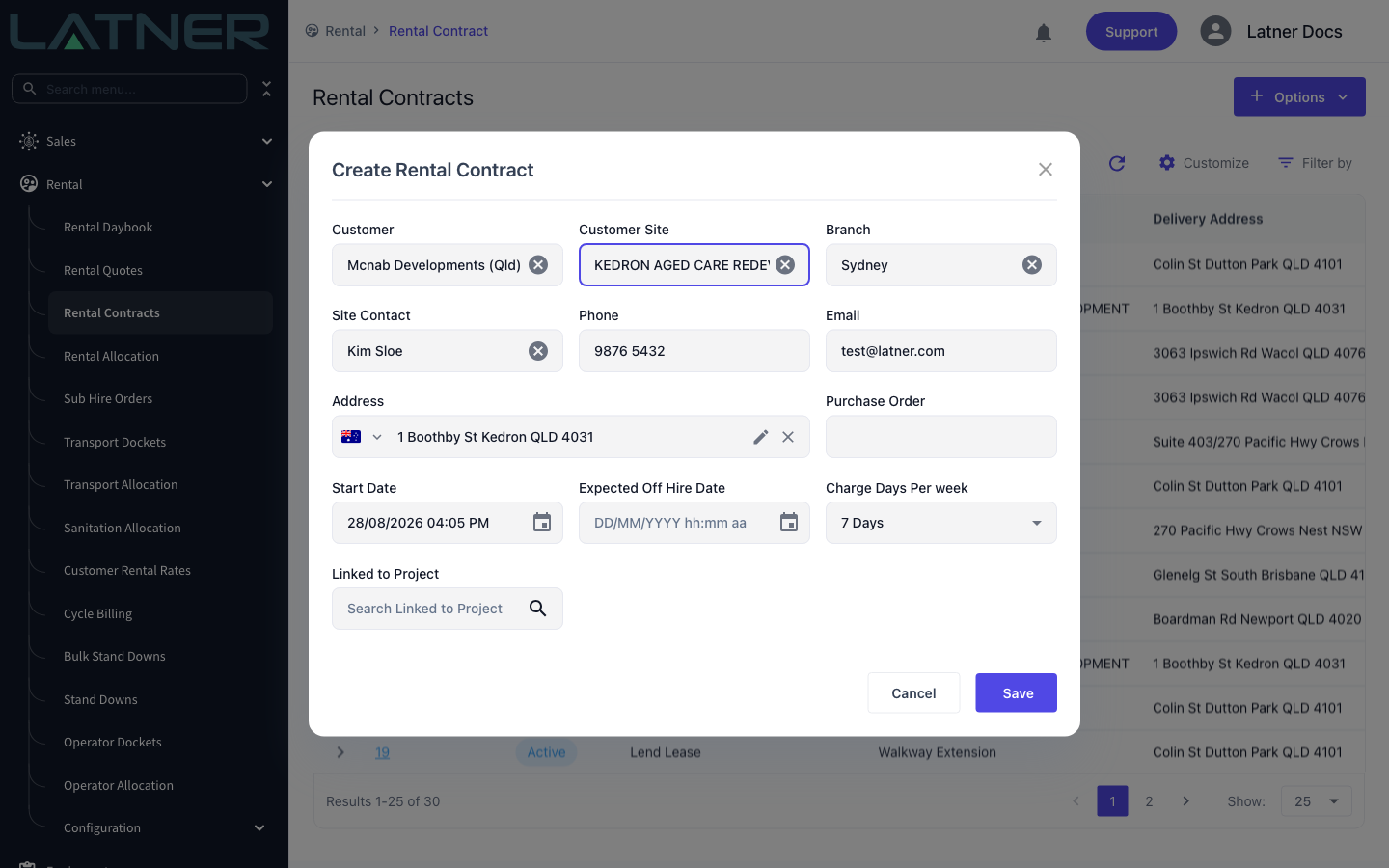

The completed form - every required field filled, with the off hire date two weeks out from the start

Step 8 - Save

Click Save. Latner creates the contract, takes you to it, and opens Add Details so you can put the first line on straight away. The dates and damage waiver you just set are carried down onto the line for you. See How to Add Equipment to a Rental Contract for what to do next.

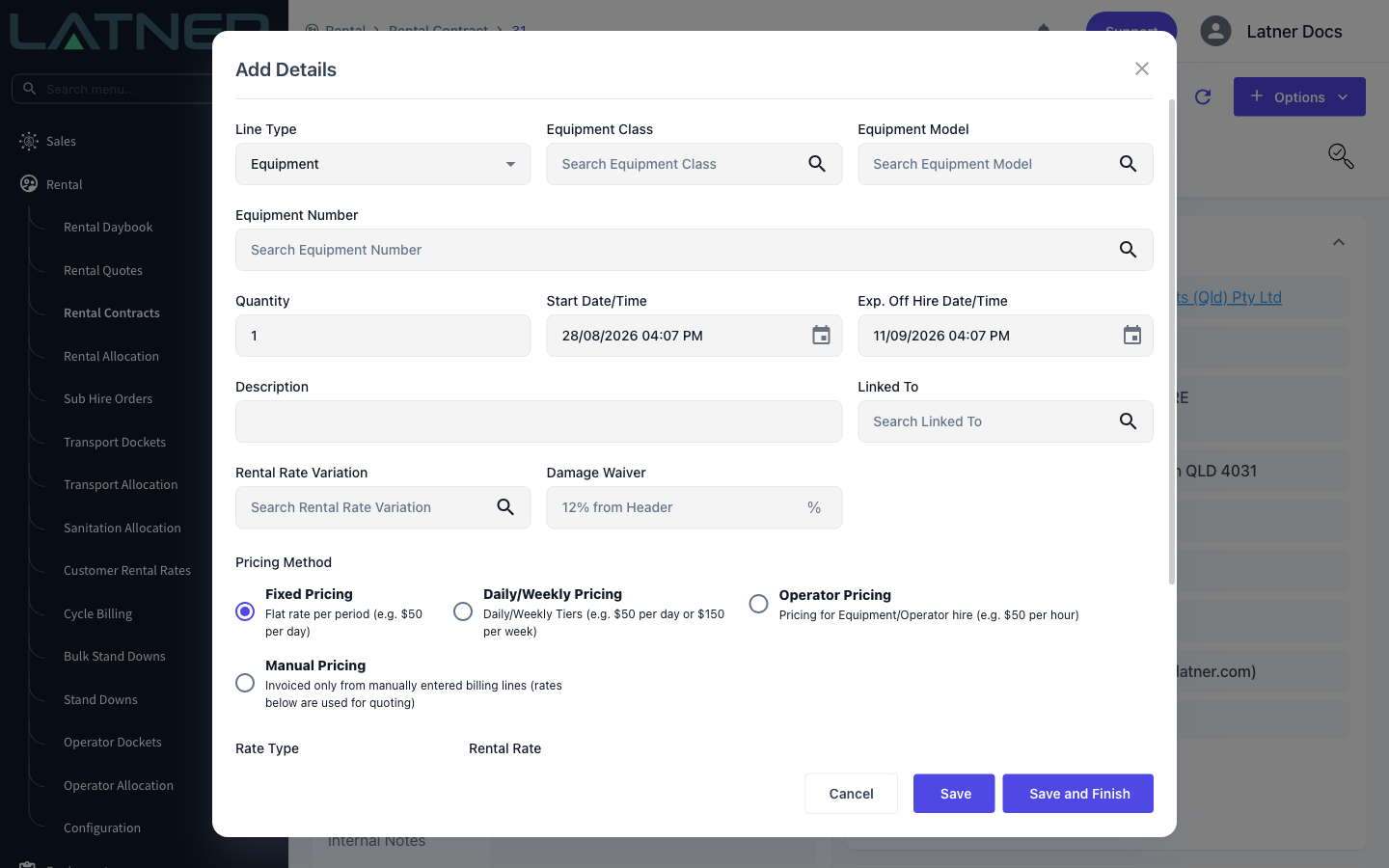

Add Details opens automatically on the new contract, pre-filled with the header dates and damage waiver

After Creation

  • The contract is given the next rental contract number and starts in Reserved status. It appears on the Rental Contracts list and on the Rental Daybook straight away.

  • Tax, transport run and delivery instructions are copied from the customer site.

  • The damage waiver and environmental levy percentages are taken from the site, then the customer, then the global rental settings, and are applied to lines you add.

  • The sales rep is set from the site, then the customer, then you as the logged-in user. With Default Sales Rep to User enabled, you are used first.

  • Everything else on the contract - notes, billing options, additional items - can be edited afterwards from the contract itself.

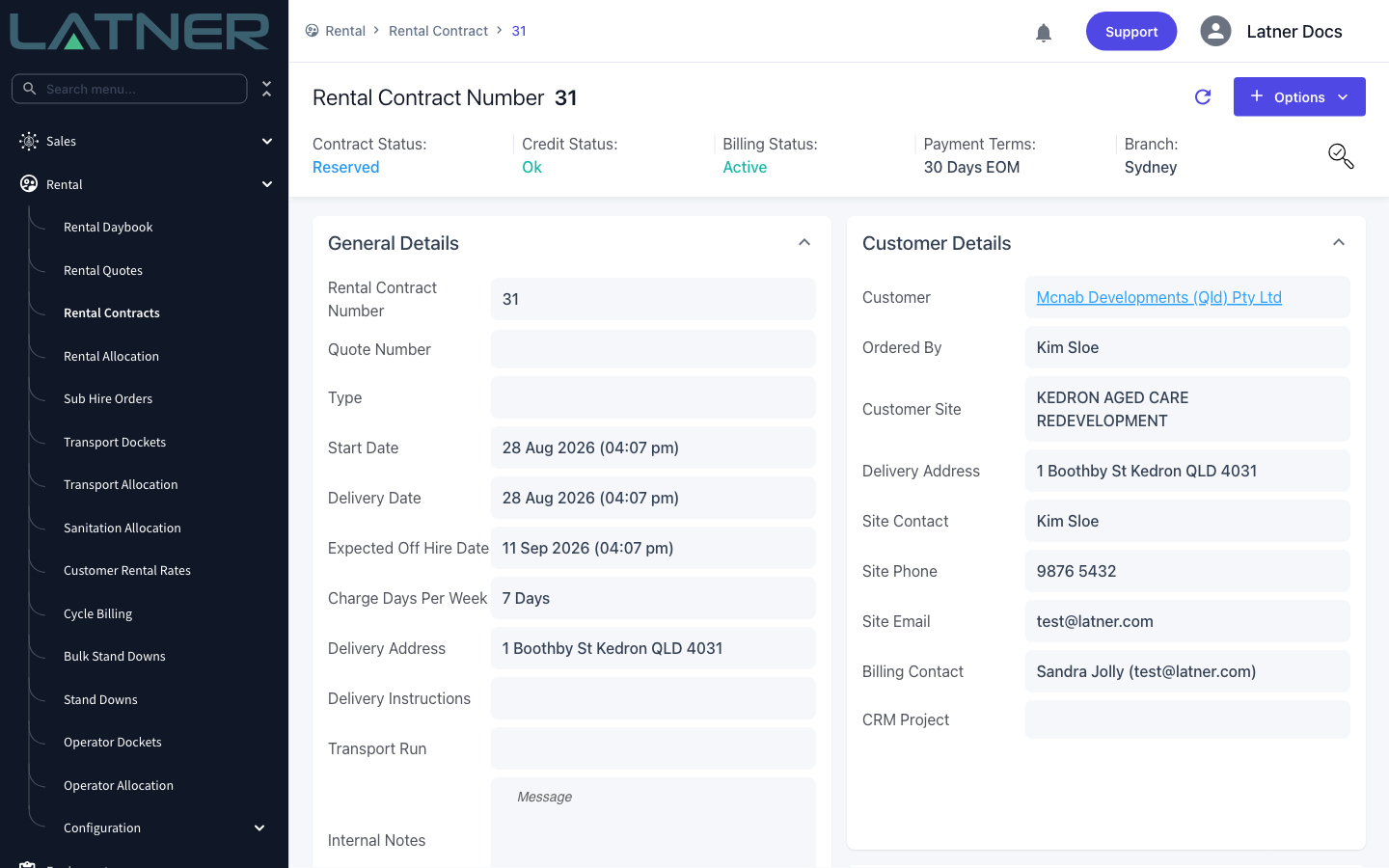

The new contract - the header strip carries the contract status, the customer's credit status and the payment terms the hire will bill on

The Customer and Branch on a saved contract can't be edited the way the other fields can - changing them affects pricing, tax and where the hire is reported. If you picked the wrong one, use Update Customer or Update Branch from the contract's Options menu rather than cancelling and starting again.

FAQs

Create Rental Contract isn't in the Options menu. Why?

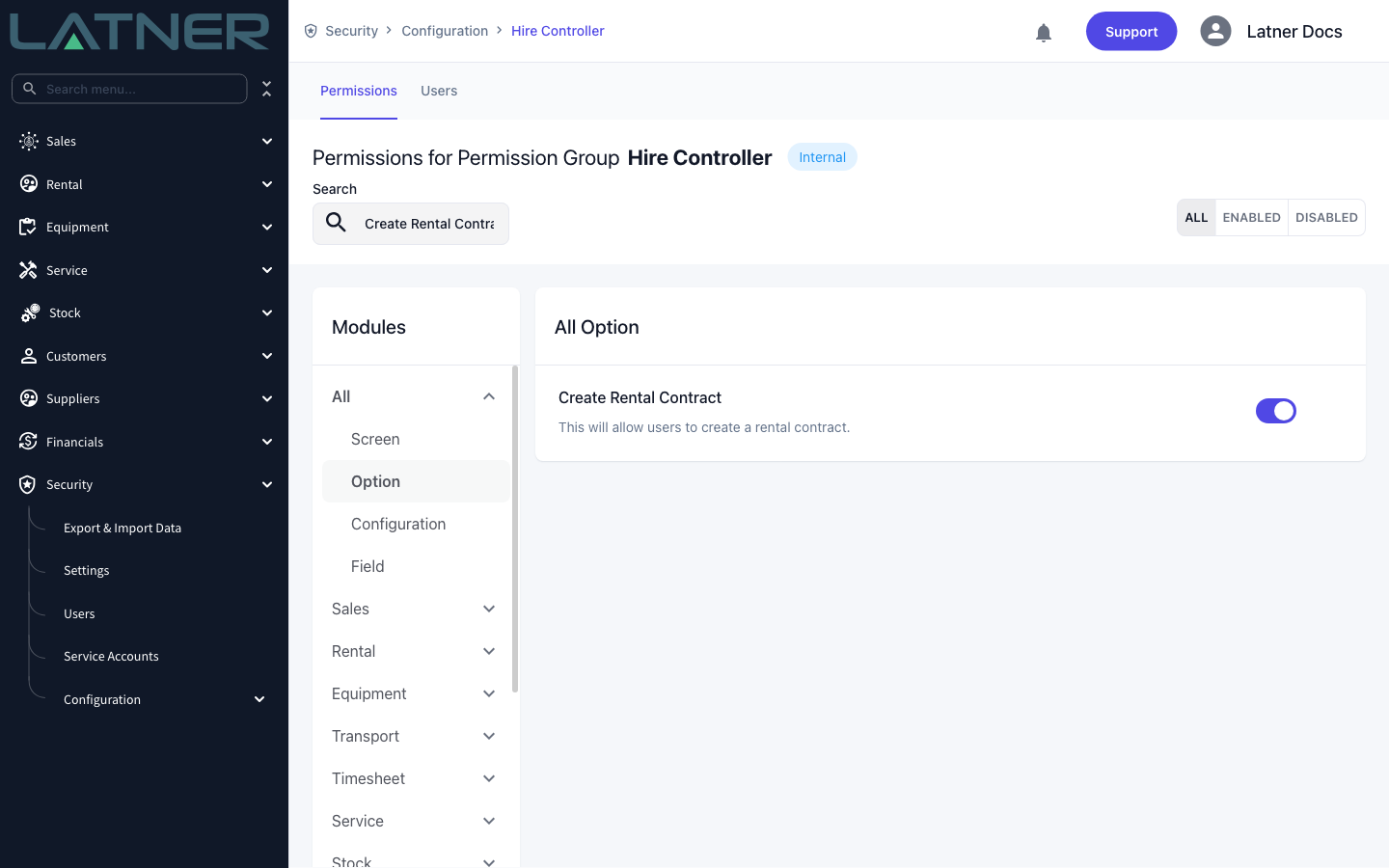

The option is gated by the Create Rental Contract permission, which sits in the Option sub-module of the Rental module. Being able to see the Rental Contracts screen is a separate permission, so you can have one without the other. Ask your administrator to enable it on your permission group.

I filled everything in but saving fails with "Customer Credit Invalid". What now?

The customer is on credit hold. Latner warns you when you select them and blocks the save when you submit, so the hire can't go out against an account that has been stopped. Nothing is created. Your accounts team can change the credit status on the customer record; contracts can be created for customers on Ok or Immediate Payment.

Saving tells me an ID number is required for a cash customer.

Your system has COD Customer ID Number Required enabled, which means cash on delivery customers must have an ID number recorded before they can hire. Add it to the customer record and save the contract again.

The site I want isn't in the Customer Site list.

The list only shows active sites belonging to the customer you selected. If the site is genuinely new, use Create New at the bottom of the list to add it without losing what you've already entered - see How to Create New Customer Sites From a Rental Contract.

Can I change the customer once the contract is saved?

Not by editing the field. Use Update Customer from the contract's Options menu, which moves the contract across properly. The same applies to the branch, which has its own Update Branch option.

Why doesn't the Charge Days Per week field appear on my form?

It's controlled by the Show Default Charge Days Per Week setting under Security › Settings › Rental. With the setting off, the contract still gets charge days - taken from the site, the customer, or the global default - you just don't get to change them at creation time.

I've created the contract but there's no equipment on it. Is that right?

Yes. Creating the contract creates the header only - the customer, site, dates and delivery details. Equipment, transport, stock and charges are added as detail lines afterwards, which is why Add Details opens for you as soon as you save.

I've made a contract by mistake. Can I delete it?

Contracts aren't deleted, they're cancelled, so the number and the audit trail survive. See How to Cancel a Rental Contract.
