Latner Documentation

How to create a Stand Down

A Stand Down records a period when hired equipment could not be used, so the customer is not charged the full rate for days the machine sat idle.

Overview

Rain shuts the site. A public holiday empties it. A machine breaks down and sits in the corner waiting on a fitter. The gear is still on hire and the meter is still running, but nobody is using it - and the customer will ask about it. A Stand Down is how you answer that question in Latner, and how you make the next invoice reflect it.

  • A Stand Down discounts one or more equipment lines on a rental contract across a date range you choose.

  • Discount % is the share of the rate you are taking off. 100% means those days are not charged at all; 50% halves them.

  • Only chargeable days count. On a contract set to 5 Days per week, a stand down that covers a weekend takes nothing off the invoice.

  • A Stand Down is saved straight into Completed status. There is no approval step - if it is wrong, you cancel it.

  • Stand Downs make no difference to lines priced on a Flat Monthly rate.

  • One Stand Down covers one rental contract. To stand down equipment across many contracts at once, use Bulk Stand Downs instead.

Before You Begin

Make sure the following are in place before you start.

Requirement

Where to Find It

Create Stand Downs permission

Security › Configuration › Permission Groups › Rental › Options

Stand Downs permission, to open the Stand Downs screen

Security › Configuration › Permission Groups › Rental › Screens

Email Rental Stand Down permission, if you want to email the stand down out

Security › Configuration › Permission Groups › Rental › Options

At least one Stand Down Reason

Rental › Configuration › Stand Down Reasons

A rental contract in Active status with equipment on it

Rental › Rental Contracts

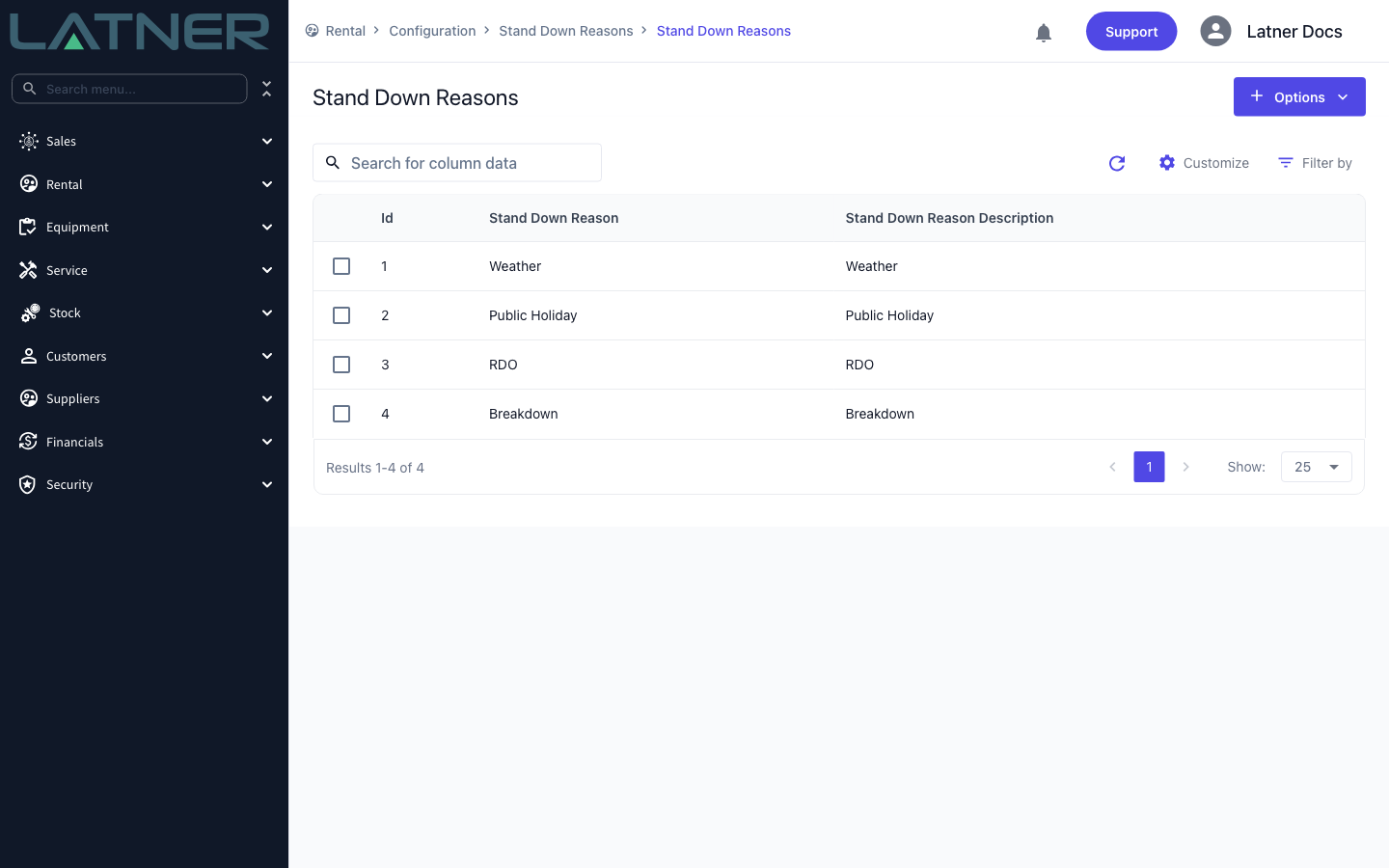

Latner ships with Weather, Public Holiday, RDO and Breakdown; add your own from Options on this screen

Stand Down Reasons are shared across every branch and every contract, and they drive your reporting. Keep the list short and meaningful - a reason you can group on later is worth more than a free-text explanation, which is what the notes field is for.

Creating the Stand Down

Step 1 - Open the rental contract

Go to Rental › Rental Contracts and open the contract the equipment is on. Check the Contract Status at the top of the page: it has to be Active. On a Reserved, Closed, Completed or Cancelled contract the Stand Down option is greyed out.

Step 2 - Choose Stand Down from Options

Select Options › Stand Down in the top right of the contract.

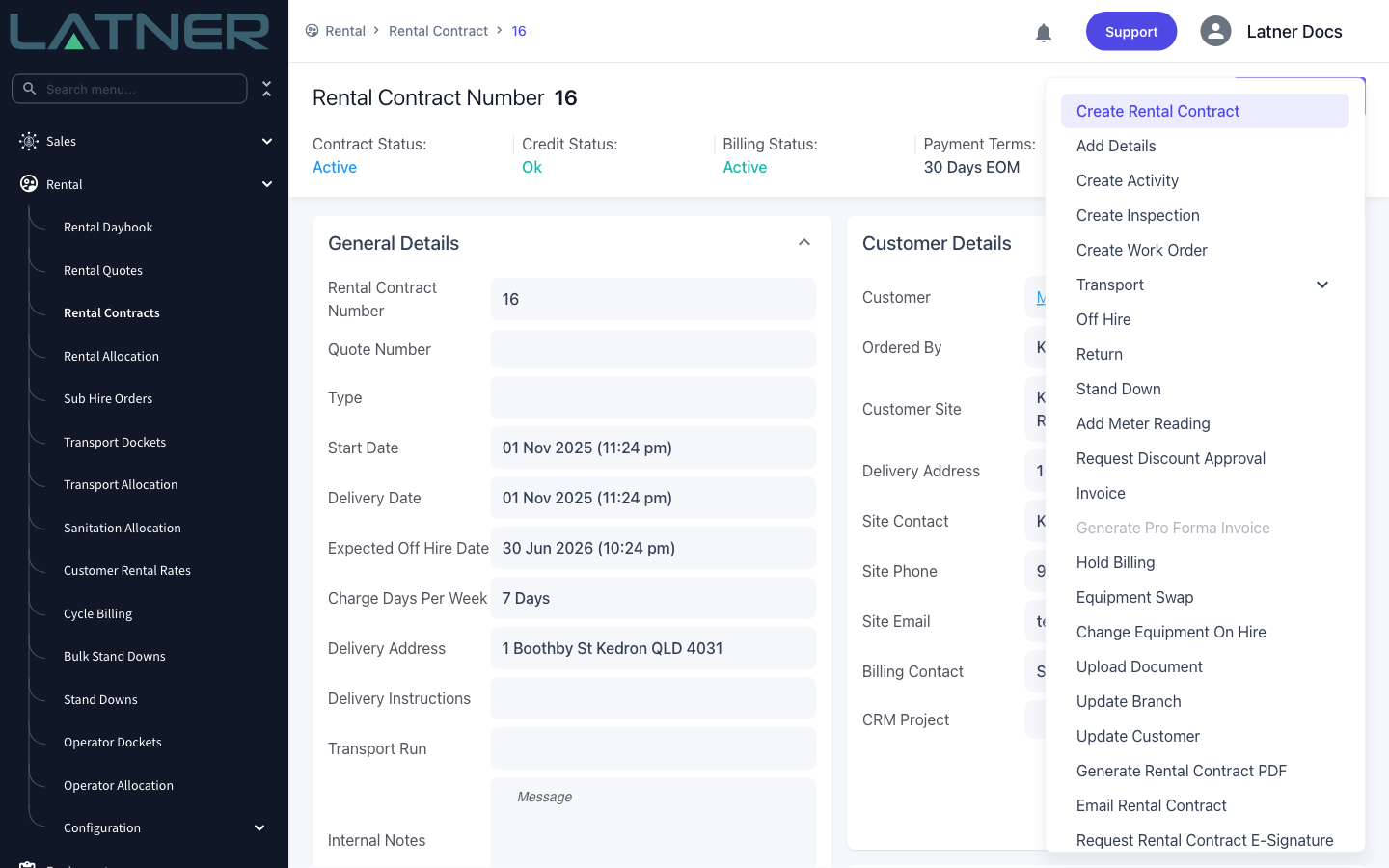

The Options menu on an Active rental contract, with Stand Down sitting between Return and Add Meter Reading

Step 3 - Pick the equipment that stood down

Rental Contract, Customer and Site are filled in from the contract and cannot be changed. Click Equipment Number and tick every line that was standing idle - it is a multi-select, so one Stand Down can cover several machines on the same contract.

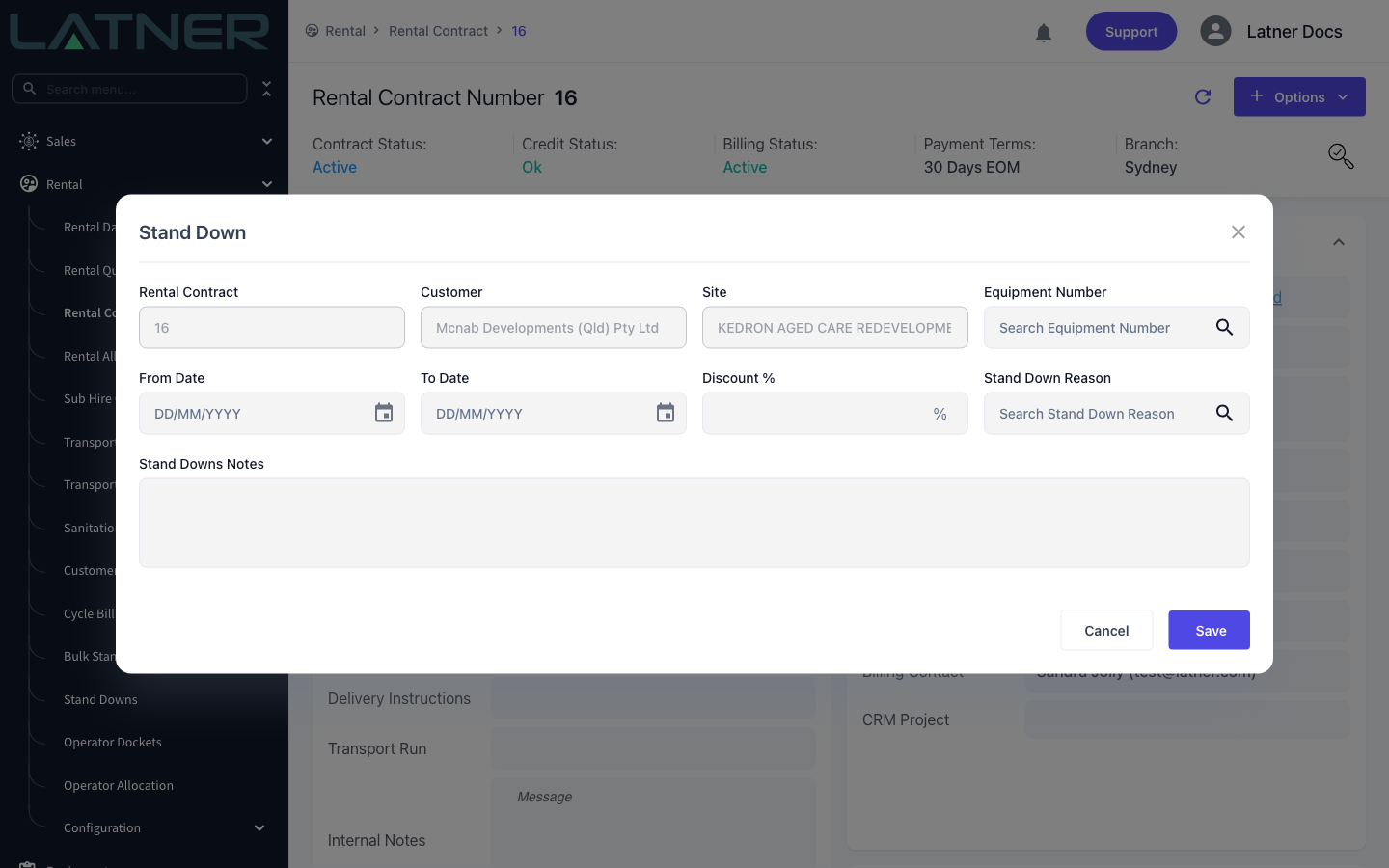

The Stand Down form opens with the contract, customer and site already filled in

The picker lists Line #, Equipment Number, Description and Status. It shows Equipment, Sub Hire Equipment and Package lines whose status is On Rent, Off Rent, Pending Pick Up, Pending Return or Returned - so you can still record a stand down for a machine that has since come back off the site.

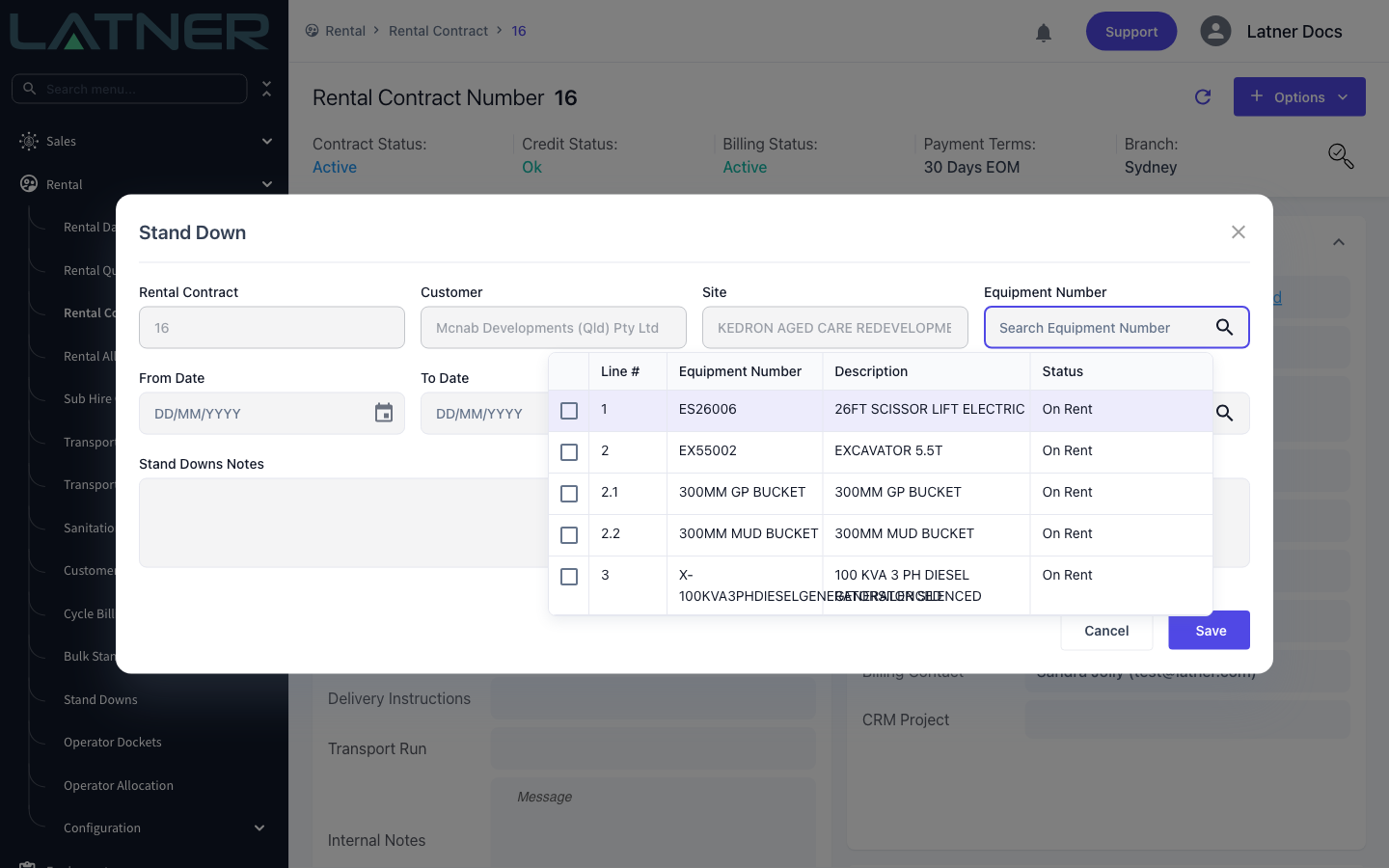

The equipment picker lists every eligible line with its number, description and current status

Lines priced on a Flat Monthly rate are highlighted in the picker, and choosing one raises the message Stand Downs have no impact on invoicing for Flat Monthly Rate Type. You can still record the stand down so the history is there - it just will not change what gets billed.

Step 4 - Set the period, the discount and the reason

Every field below is required.

  • From Date - the first day the equipment stood idle.

  • To Date - the last day. It can be the same day as From Date, but not earlier, or you will get To Date must occur after From Date.

  • Discount % - how much of the rate to take off across those days. Enter 100 for days you are not charging at all.

  • Stand Down Reason - pick from your configured list.

  • Stand Downs Notes - the free-text explanation. This is what the customer sees if you email the stand down, so write it for them, not for yourself.

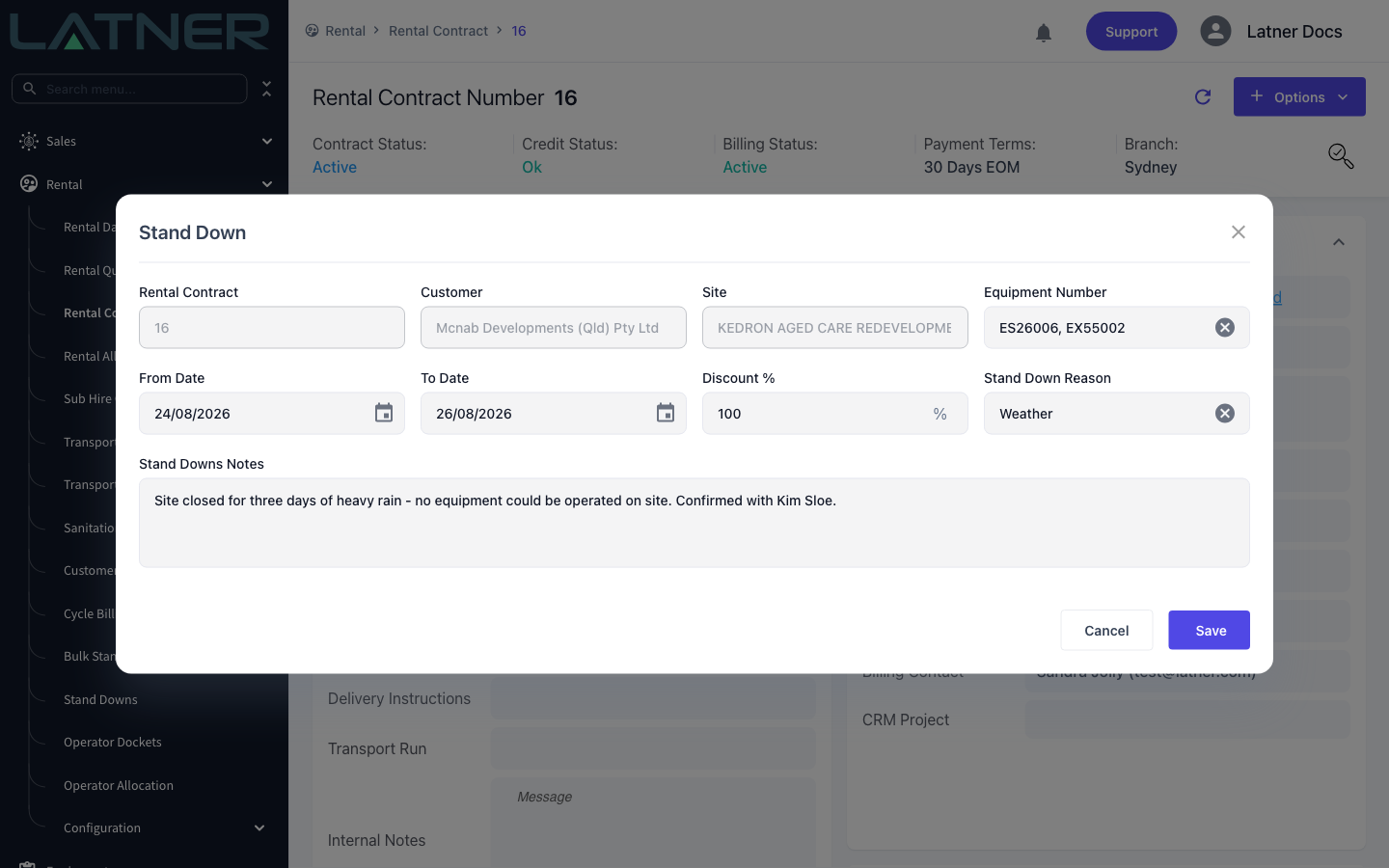

A completed three-day weather stand down at 100% - the notes name the person on site who confirmed it

Step 5 - Save

Click Save. Latner creates the Stand Down in Completed status and asks whether you want to let anyone know about it. Choose Yes to go straight to the new record with the email dialog open, or No to finish here - you can email it later from the Stand Down itself.

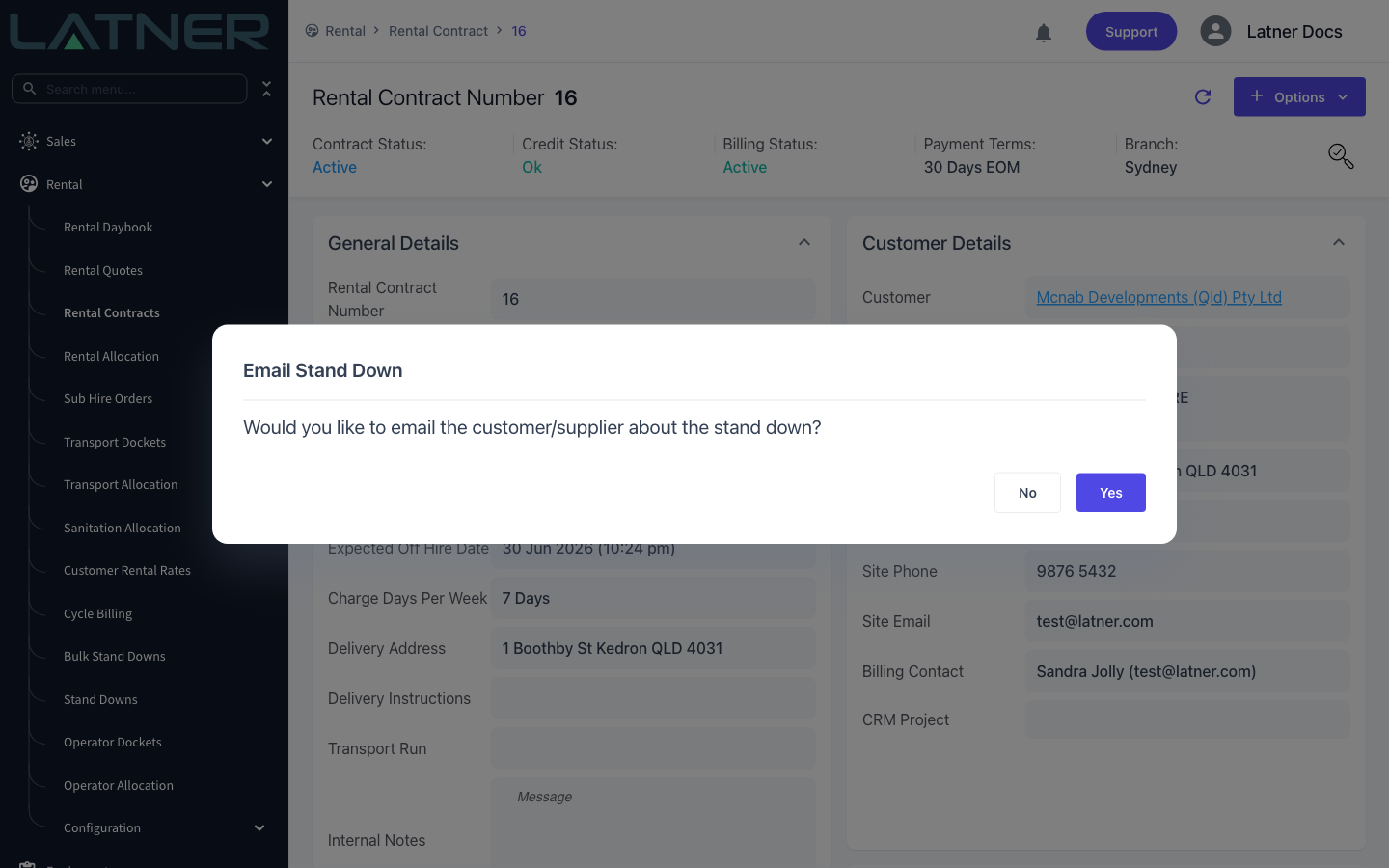

The prompt that follows a successful save; answering No does not stop you emailing the stand down later

If the period you have chosen has already been invoiced, Latner stops and asks first: You are about to create a Stand Down that covers a period that is already Invoiced. An alternative approach would be to create a Manual Credit Note for the Stand Down day(s). Are you sure that you want to continue? Take the warning seriously. A credit note against the invoice you already sent is usually cleaner for the customer to follow than a discount buried in the next one.

After Creation

  • The Stand Down gets its own numbered record under Rental › Stand Downs, in Completed status.

  • Each piece of equipment you selected becomes a row on the Stand Down's Details tab.

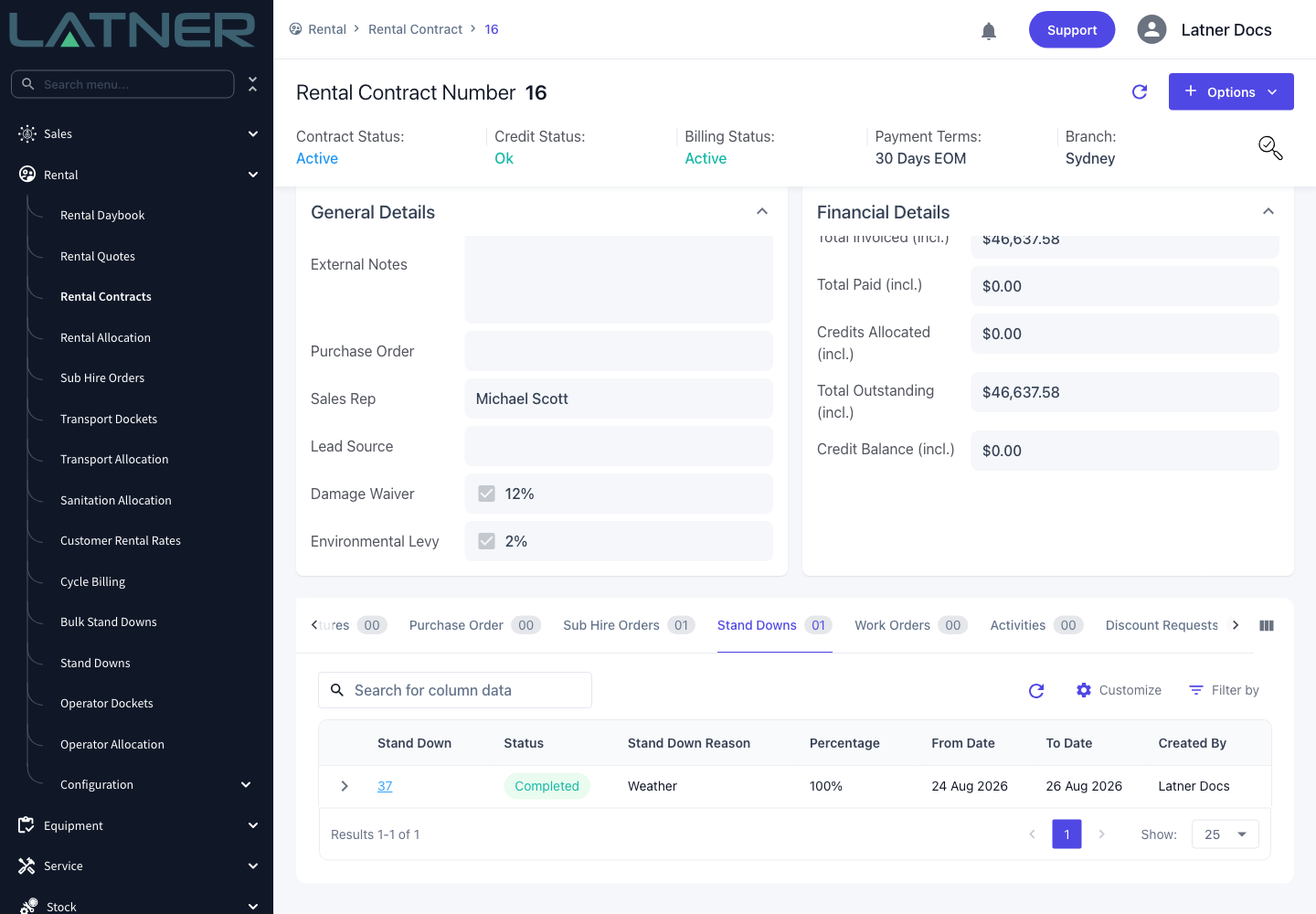

  • The Stand Down also appears on the contract's Stand Downs tab, with its reason, percentage and dates.

  • Estimated Cost on each detail row stays empty until the invoice covering those days is raised. Latner then fills it with the value that line actually gave back.

  • The next invoice for those lines bills fewer days - the stand down days multiplied by the discount are taken off the days on rent.

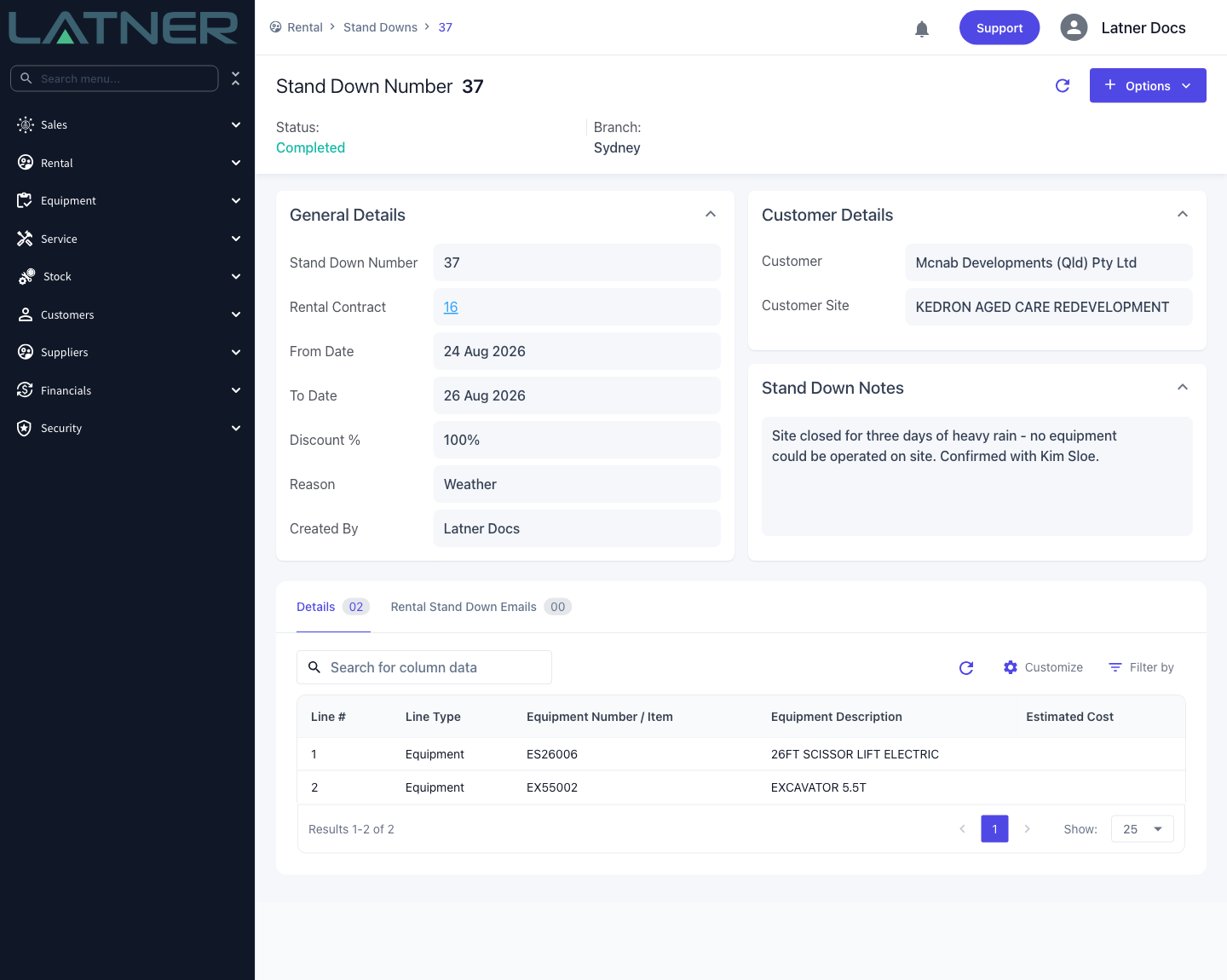

The new Stand Down record - Estimated Cost is blank on both lines because this period has not been invoiced yet
The same stand down on the contract's Stand Downs tab, where anyone looking at the contract will find it

Two Completed Stand Downs cannot cover the same equipment line on overlapping dates - Latner rejects the second one with Stand Down dates cannot overlap with an existing Completed Stand Down. If the period really has changed, edit the existing Stand Down or cancel it rather than stacking a second one on top.

Emailing the Stand Down

On the Stand Down, choose Options › Email Stand Down. Pick Customer or Supplier as the Email Recipient - choosing Supplier also asks you which supplier - then Save to open the message. The recipient, subject and body are pre-filled from your branch's email settings under Security › Settings › Email, and you can edit any of it and attach files before sending.

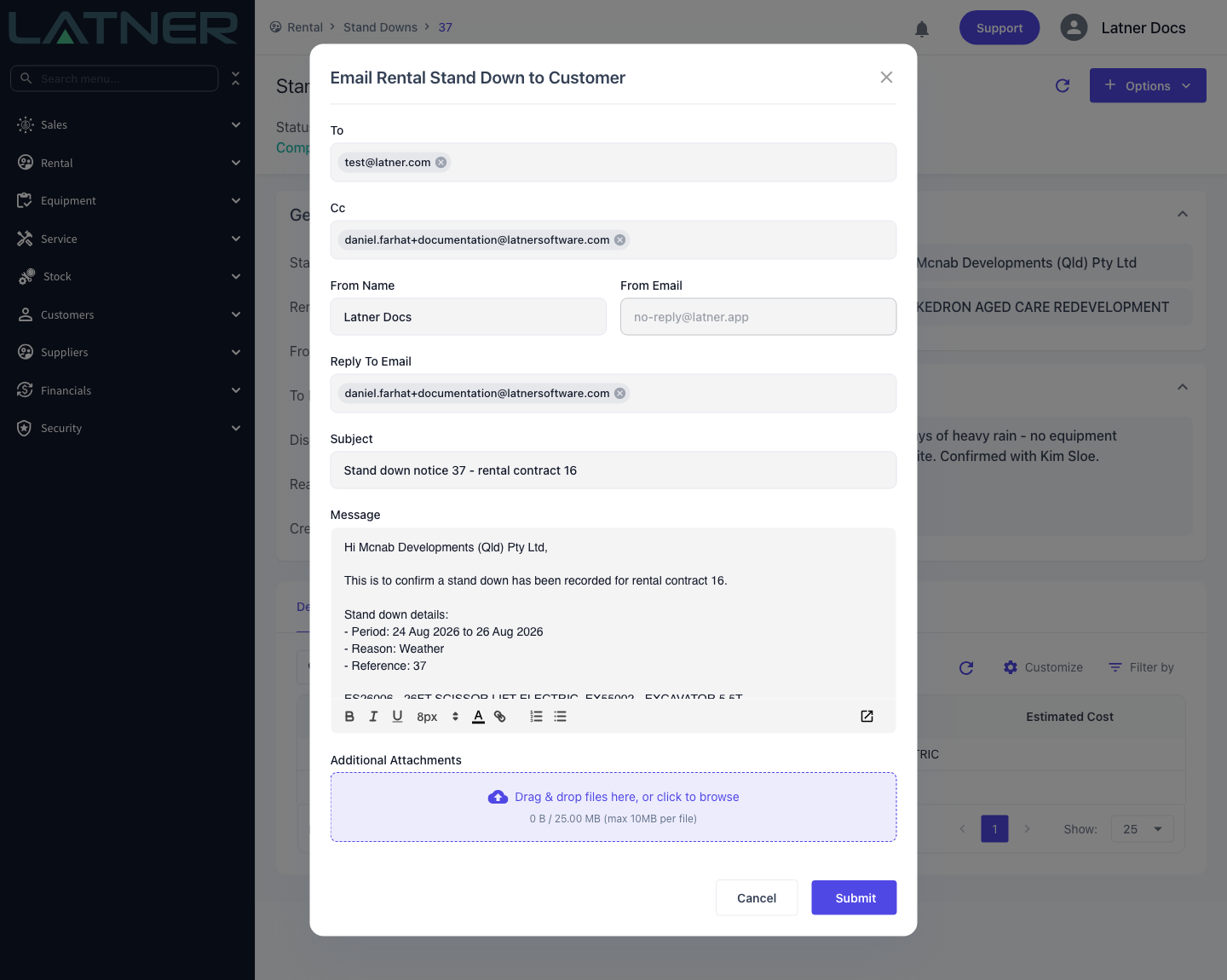

The pre-filled customer email - the period, reason, stand down number and affected equipment are all merged in for you

Sent messages are kept on the Rental Stand Down Emails tab of the Stand Down, so there is a record of who was told and when.

Editing or cancelling a Stand Down

From Date, To Date, Discount % and the notes can all be edited on the Stand Down record while the period is still uninvoiced. Once an invoice has covered it, Latner locks the fields that would change what was billed.

To reverse a Stand Down entirely, choose Options › Cancel Stand Down and confirm. The record moves to Cancelled and stops affecting billing; it is not deleted, so the history stays intact.

FAQs

The Stand Down option is greyed out on the contract. Why?

The contract is not Active. Stand Down is only available while Contract Status is Active - a Reserved contract has not started yet, and a Closed, Completed or Cancelled one is finished. If the option is missing from the menu altogether rather than greyed out, you do not have the Create Stand Downs permission.

Can I stand down equipment that has already been returned?

Yes. The equipment picker includes lines that are On Rent, Off Rent, Pending Pick Up, Pending Return or Returned, so you can record a stand down after the fact - as long as the contract itself is still Active.

I created a Stand Down but the invoice has not changed. What happened?

Three things usually explain it. The line may be priced on a Flat Monthly rate, which stand downs do not affect. The stand down days may not be chargeable days - on a 5 Days contract, a Saturday and Sunday stand down removes nothing. Or the period was already invoiced, in which case the adjustment does not appear retrospectively on the invoice you have already sent.

Can I change the dates or the discount after saving?

Yes, while the period is still uninvoiced. Once an invoice covers it, Latner blocks the changes that would rewrite what was billed - you will see Cannot update Percentage if the stand down has already been invoiced, Cannot move From Date to before the last invoiced datetime or Cannot move To Date to before the last invoiced datetime. Extending the stand down forward into an uninvoiced period is still fine.

How do I reverse a Stand Down?

Open it and choose Options › Cancel Stand Down. If the period has already been invoiced the confirmation warns you that cancelling may produce adjustments on the next invoice. You cannot cancel a Stand Down whose rental contract has been closed or completed - Latner returns Can't cancel a Stand Down for a Closed/Completed Rental Contract.

Why is Estimated Cost empty on the Details tab?

Because nothing has been billed for that period yet. Estimated Cost is worked out when the invoice covering the stand down is created, from the stand down days, the discount and that line's daily rate. A blank value means the saving is still ahead of you, not that the stand down failed.

A whole yard was rained out. Do I have to do this contract by contract?

No. Use Rental › Bulk Stand Downs, which applies one reason, period and discount across equipment on many contracts in a single run. See How to Create Bulk Stand Downs.

Watch the Demo

Prefer to watch it? Step through the same flow here.
